FRESH FIELDS, WA
PROJECT PORTAL
This private project portal is designed to provide clear, real-time visibility across each stage of Fresh Fields construction. Here you can access updates, documentation and site imagery all in one central, easy-to-navigate space.
YOUR PROJECT TEAM
Site Supervisor
Greg Dowse - Mayfair BC
greg@mayfairbc.au
0407 755 266
Project Manager
Jamie de Beaux - Maxi Projects
jd@maxipm.au
0410 524 862
Architecture & Design
Ben Murdock - Archive Office
ben@archive-office.com
0401 281 598
PROJECT UPDATES
-
Provided by Site Supervisor Greg Dowse

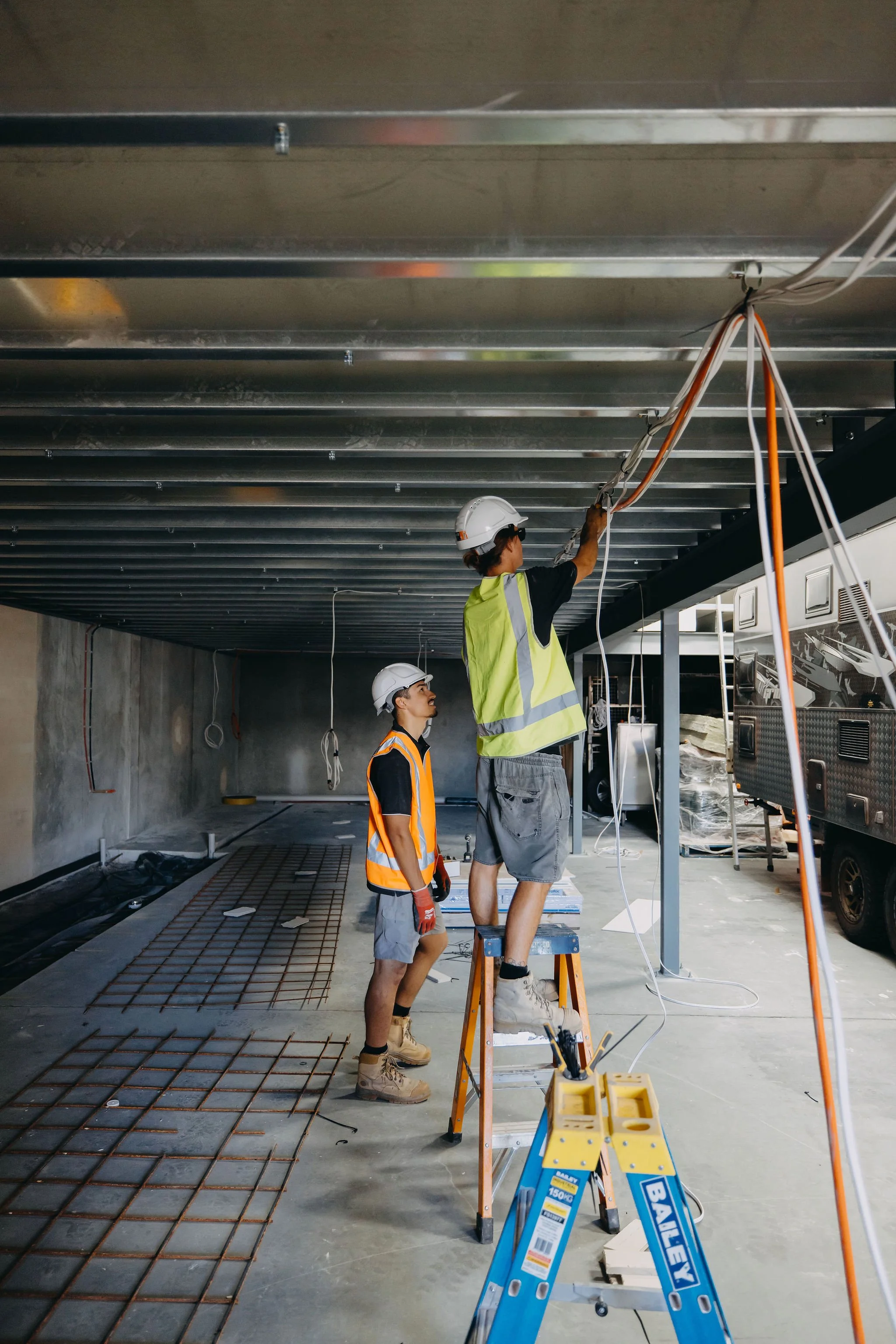

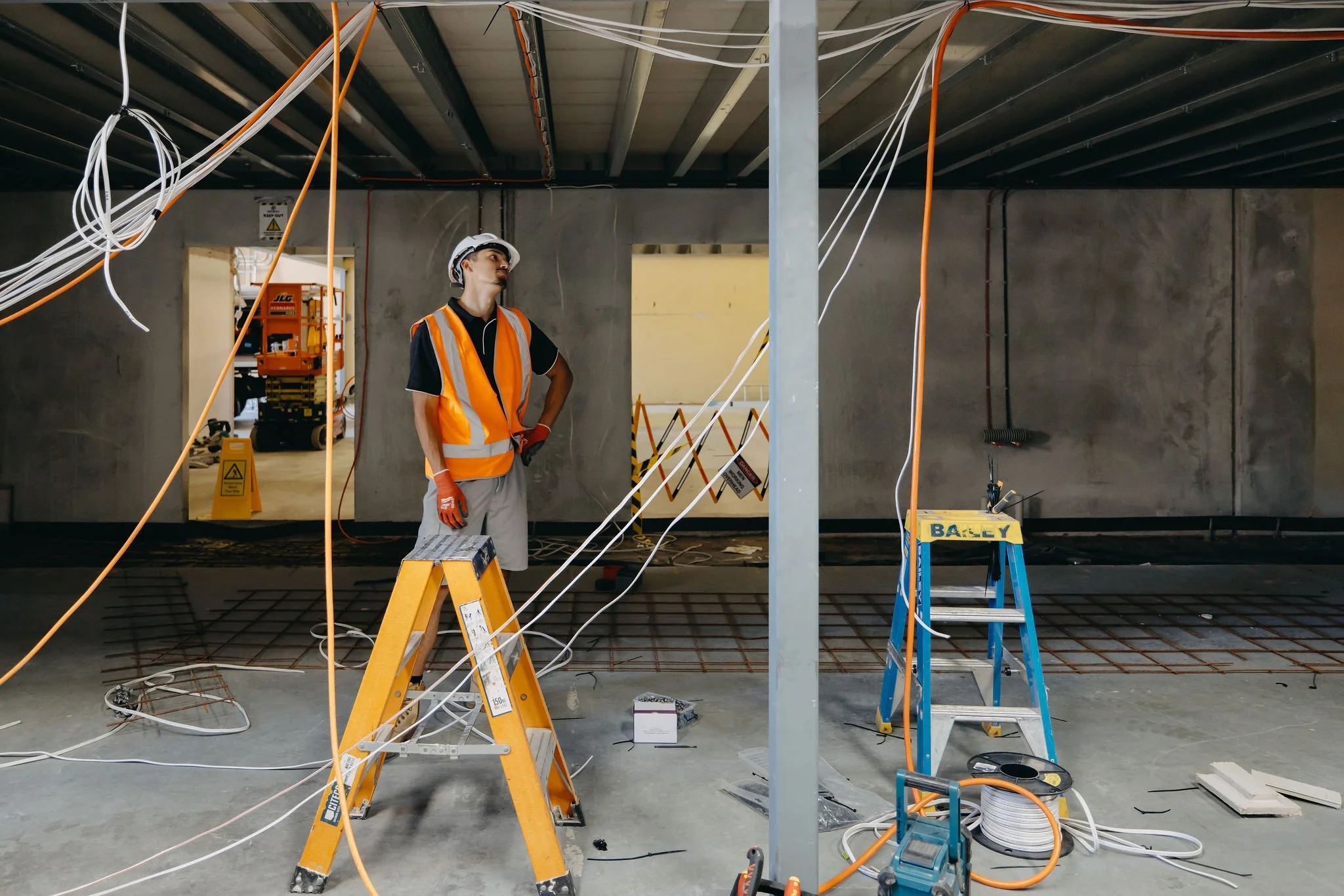

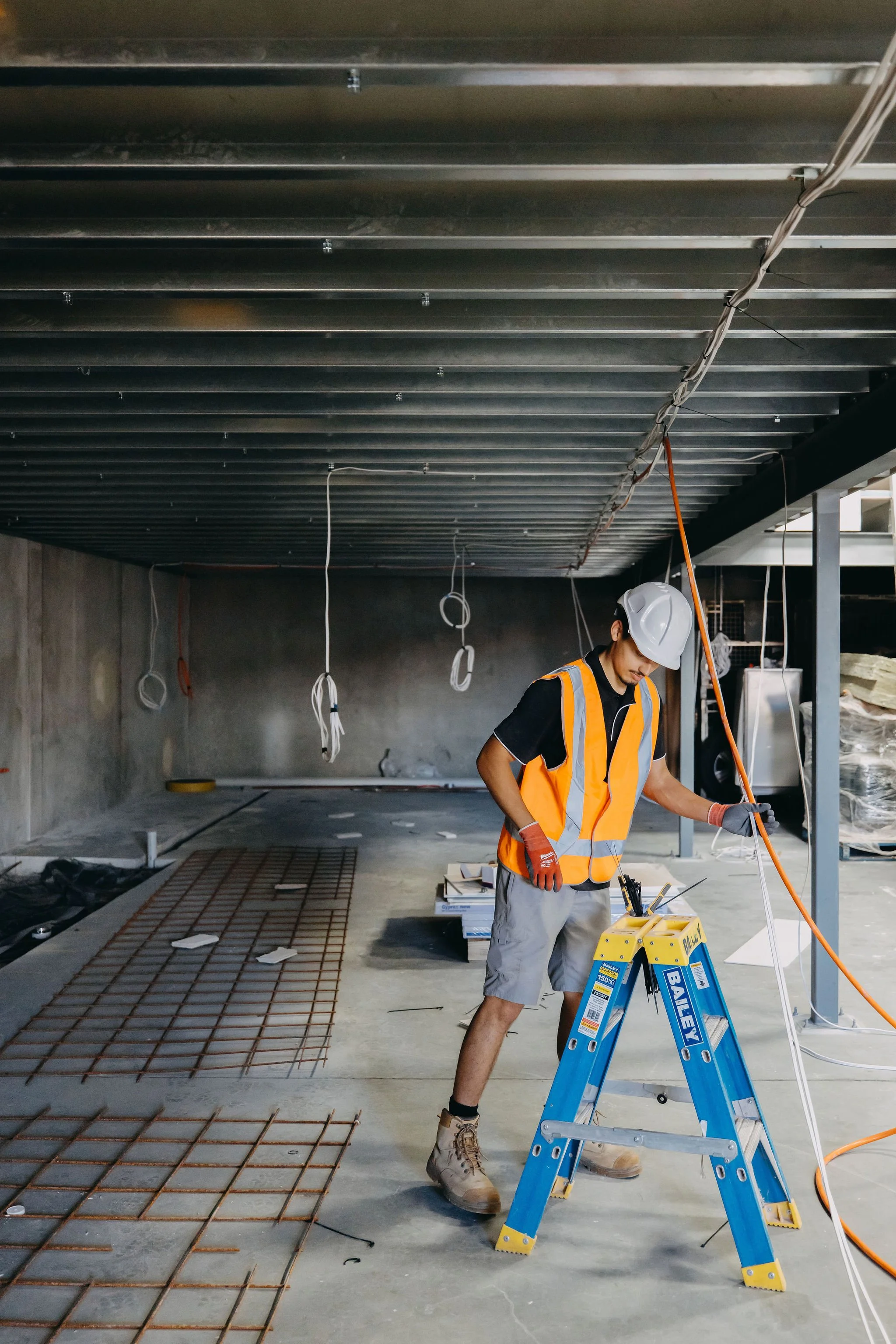

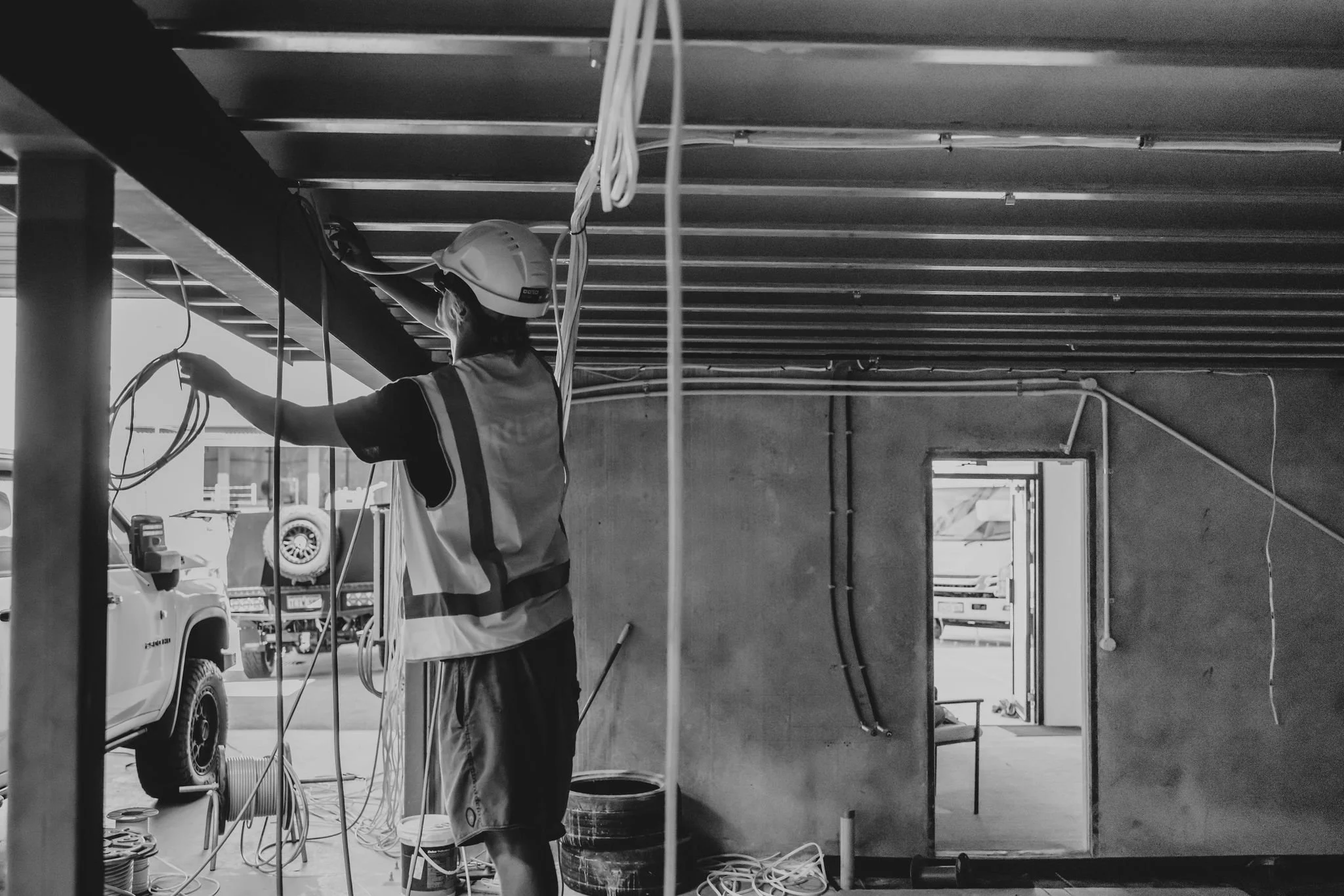

Electrical pre-lay works ongoing, with updated pricing received in line with revised drawings.

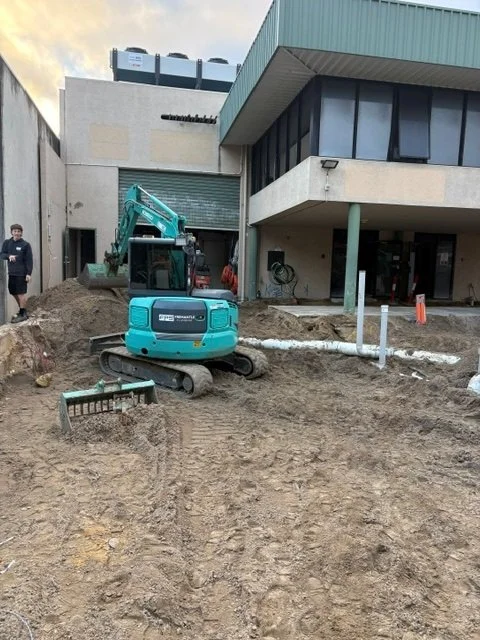

Earthworks and Electrical pre lay

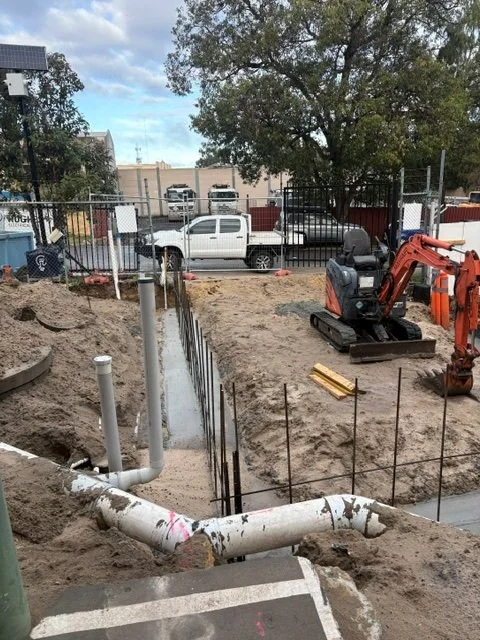

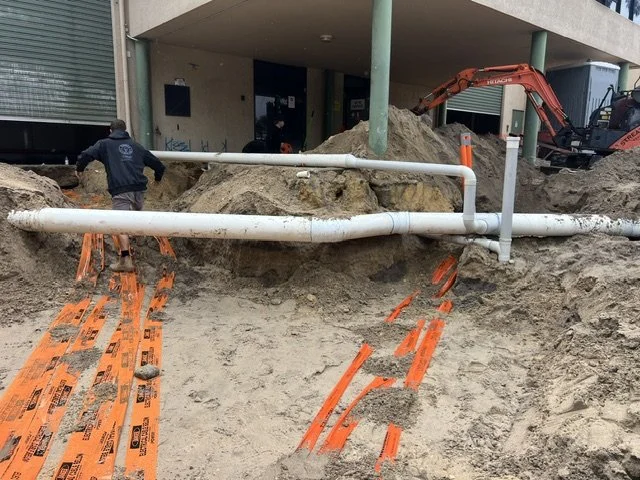

The earthworks and electrical pre-lay works have progressed well and are now complete.

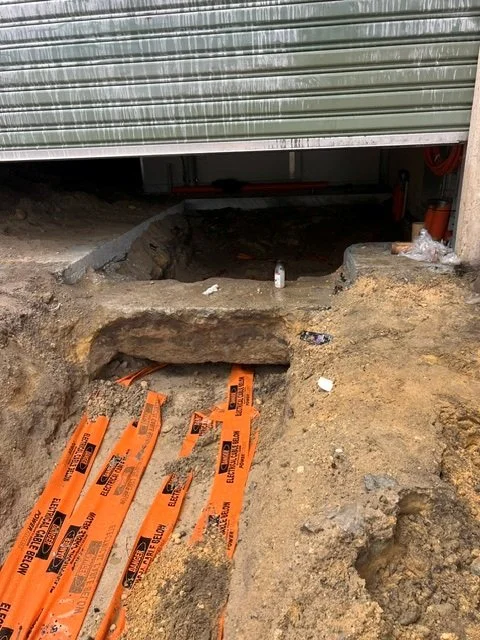

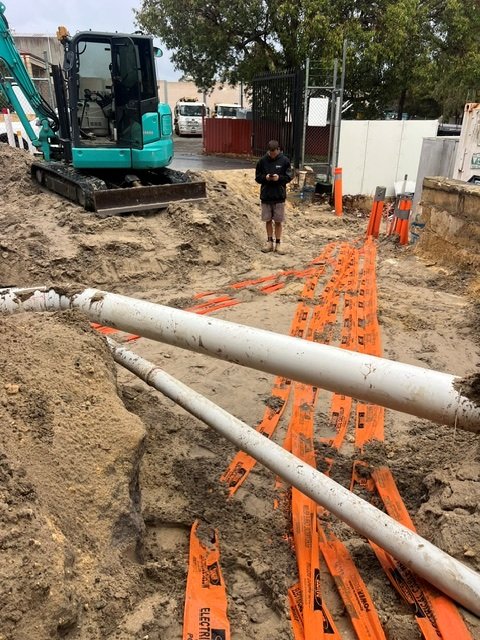

All conduits have been installed, and the required cables have been pulled through to the correct locations. The walls have also been core drilled, allowing the internal cabling to be pulled through within Lot 110.
Following completion of these works, all trenches have been backfilled and the area made ready for the next stage of construction.

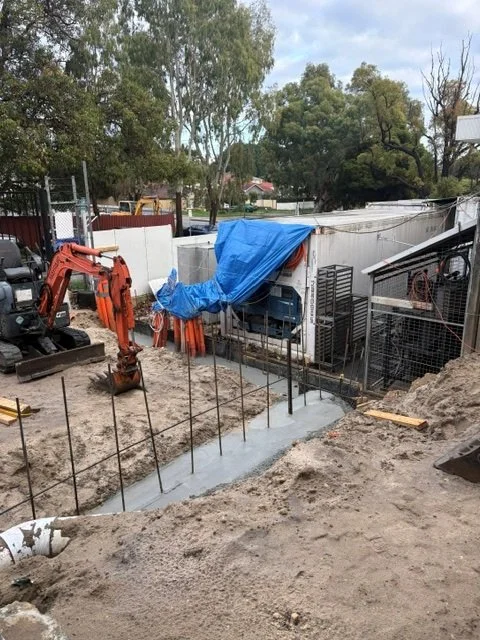

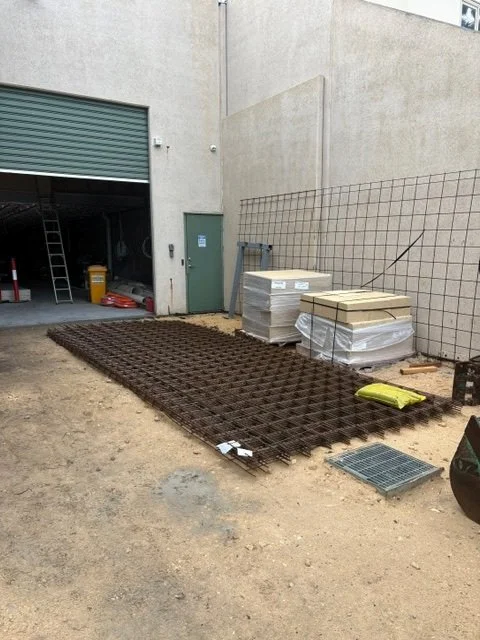

Retaining walls and footings
Good progress has been made on the retaining wall works over the past fortnight.

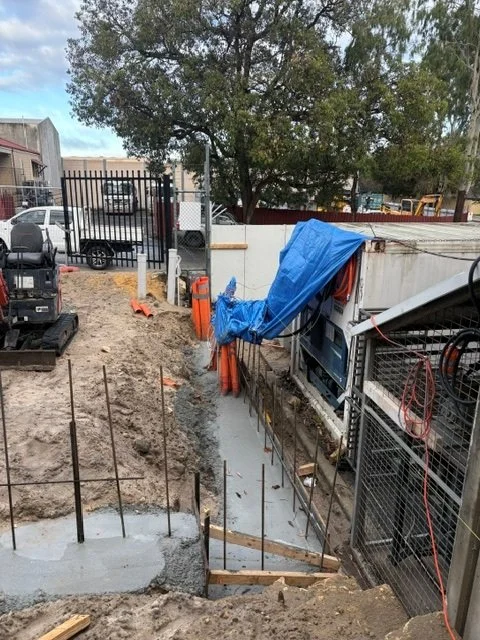

All required footing excavations have been completed, with the reinforcement steel and mesh installed and the concrete footings now poured.
The existing retaining walls between Lots 110 and 111 have also been removed to accommodate the new footings and proposed retaining wall construction.
The bricklayers are scheduled to commence construction of the retaining walls along the driveways during the coming week.

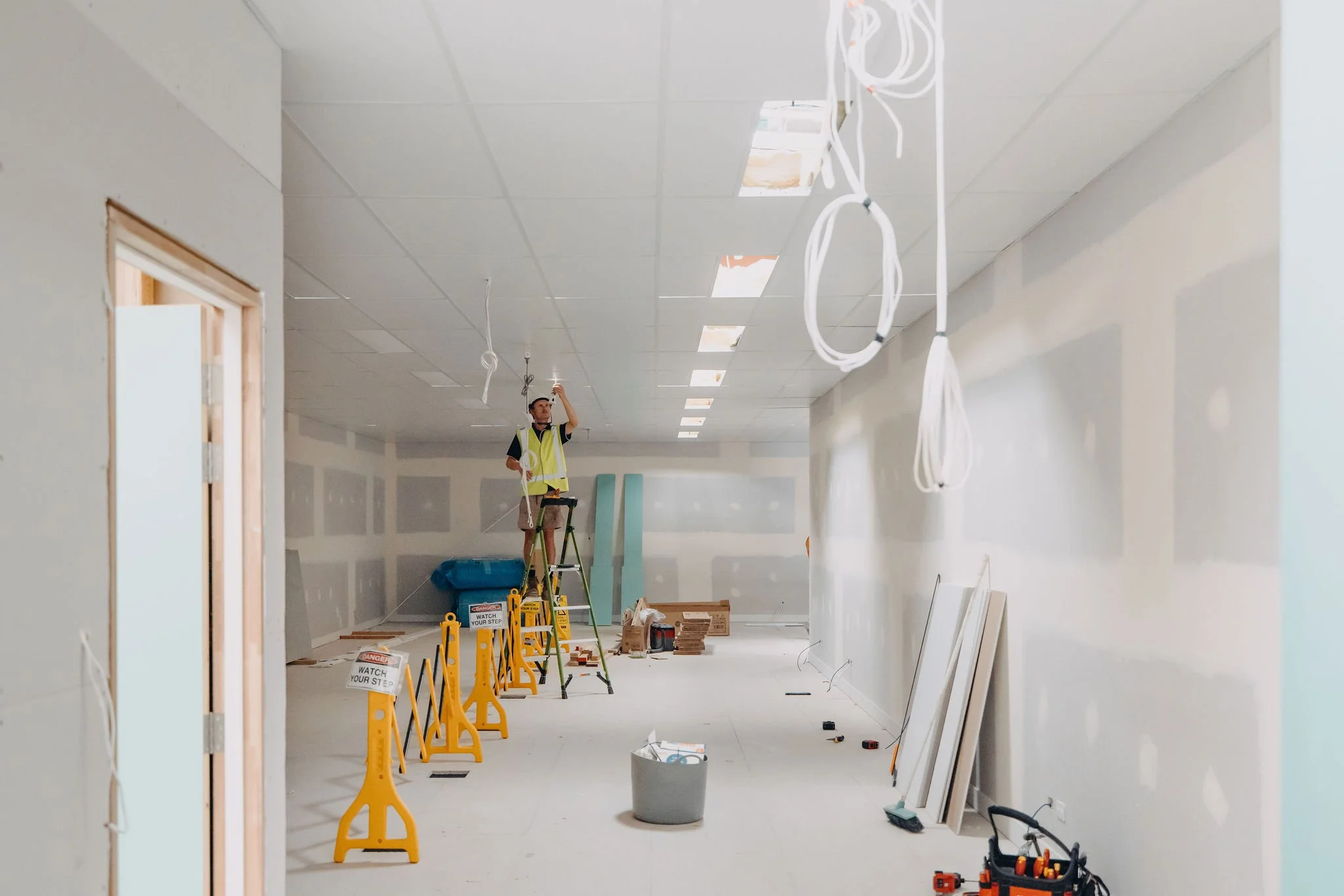

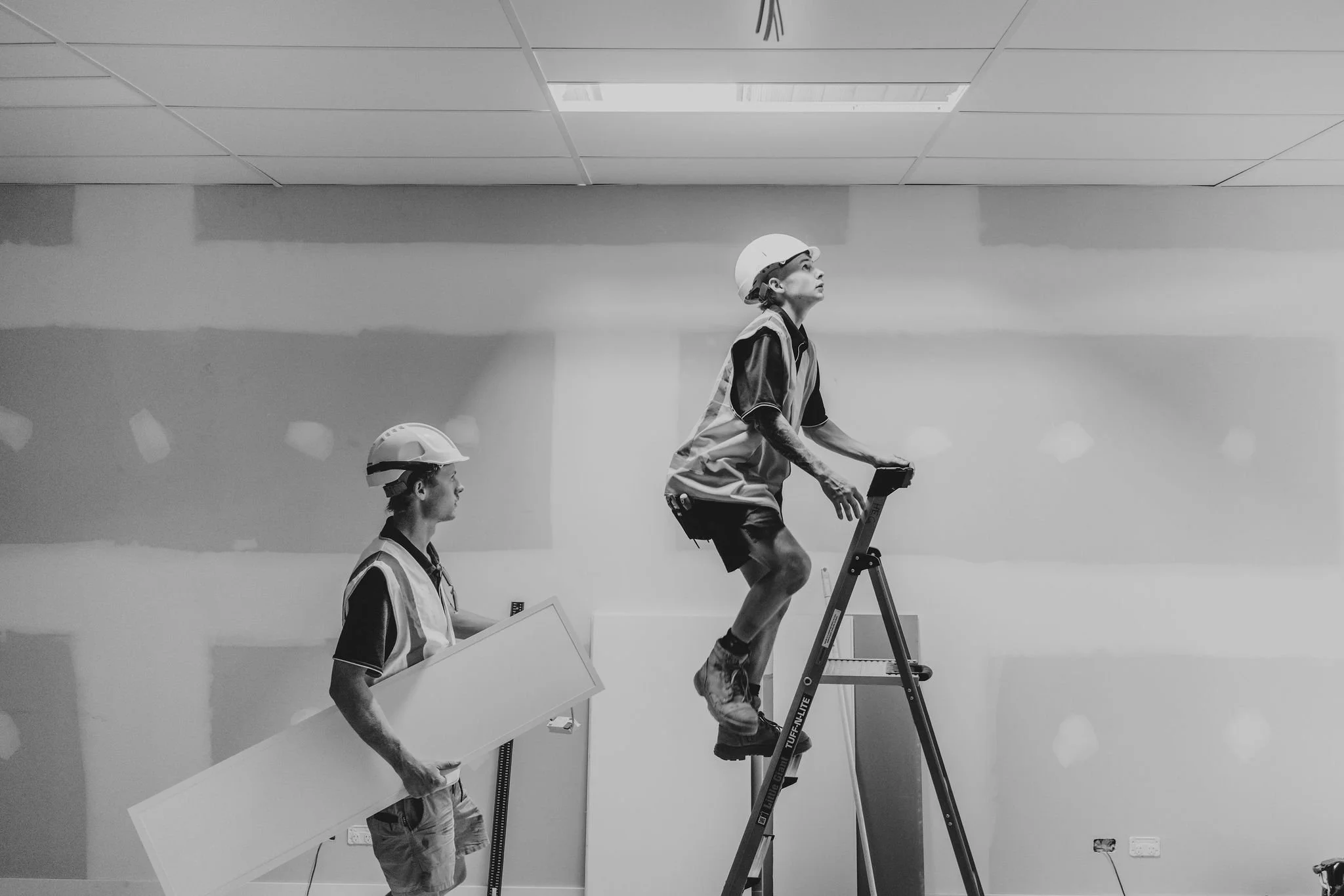

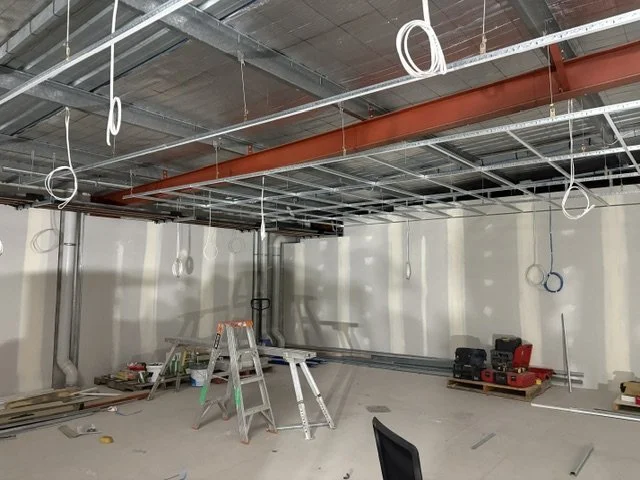

Internal Linings and Finishes

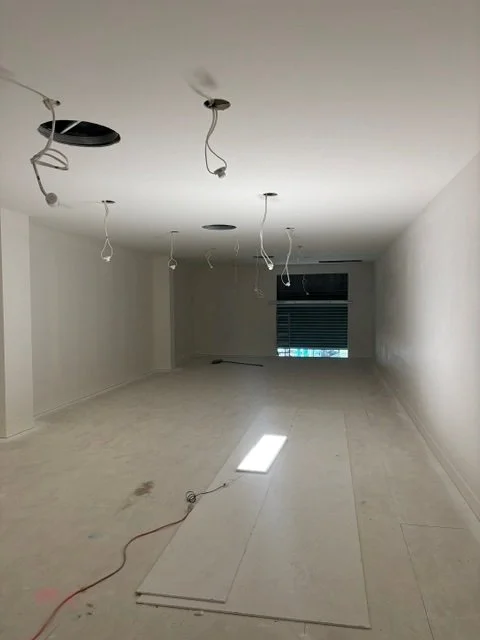

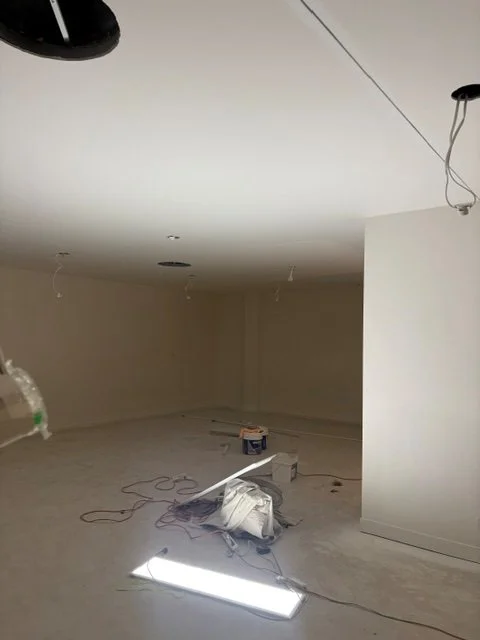

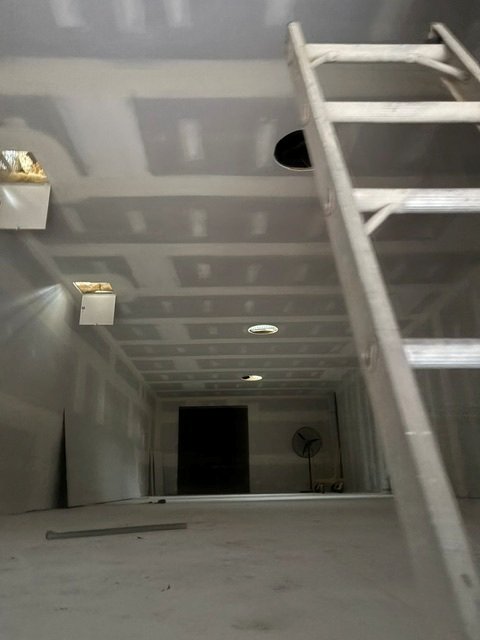

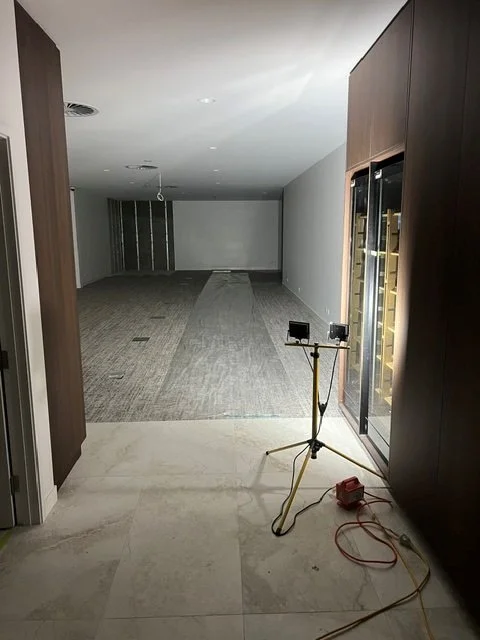

Good progress has continued within the CEO’s mezzanine. Gyprocking to the CEO’s mezzanine has been completed, including all flushing and sanding works.
The required air-conditioning and electrical cut-outs have also been completed.

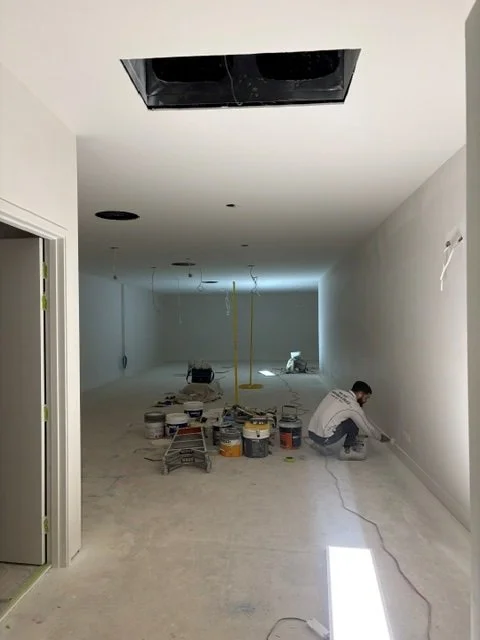

Painters are now on site, with painting scheduled to be completed this week
The tiler is booked to commence this week. Following completion of the tiling, the cabinetmaker will attend site to install the cabinetry, with carpet installation to follow.
Framing, insulation and gyprocking works to the walls and ceilings have also commenced within the mezzanine located above the refrigeration panels.
Stair Demolition and Installation of New Stairs

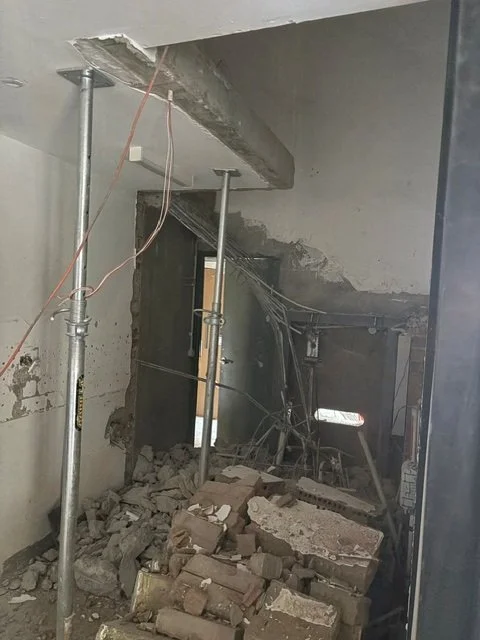

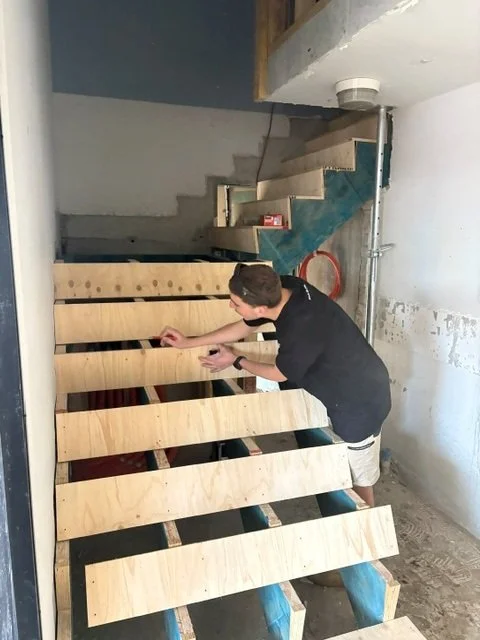

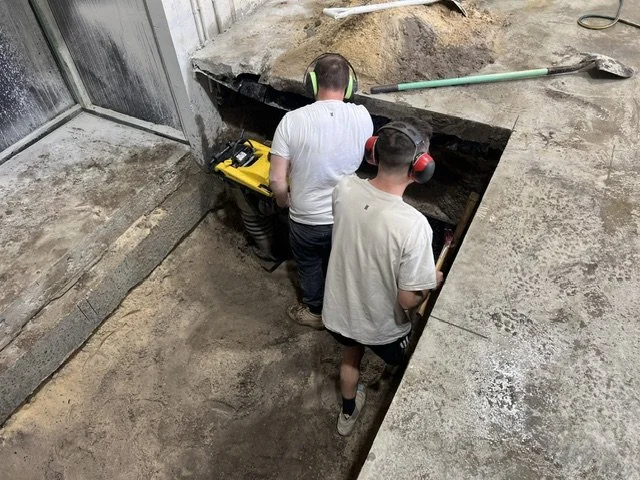

The existing concrete stairs have been removed, and the suspended slab has been cut out and widened as required.

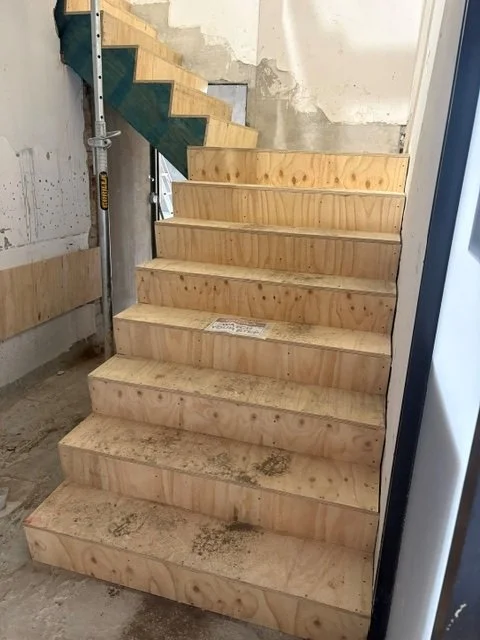

Construction of the two new sets of stairs has now been completed. An additional staircase has also been constructed to provide access to the mezzanine located above the refrigeration panels.
Tiling – Staff Bathrooms and CEO’s Mezzanine
With the stair demolition and associated structural works now complete, the staff bathroom tiling can proceed.
The tiler is scheduled to commence on site on Monday, 20 July, with tiling works also beginning within the CEO’s mezzanine.

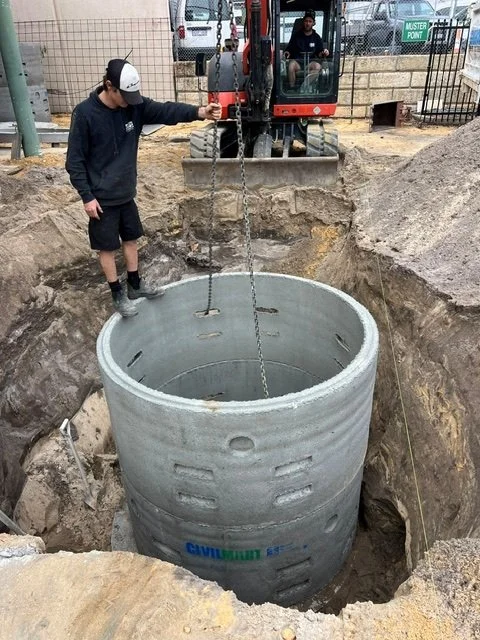

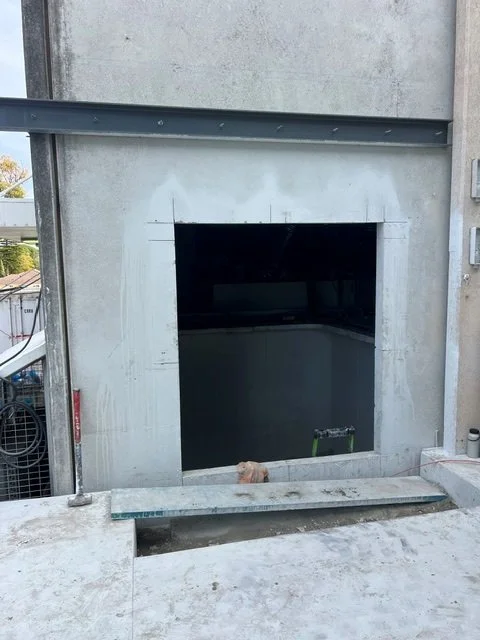

Loading dock and Excavation works

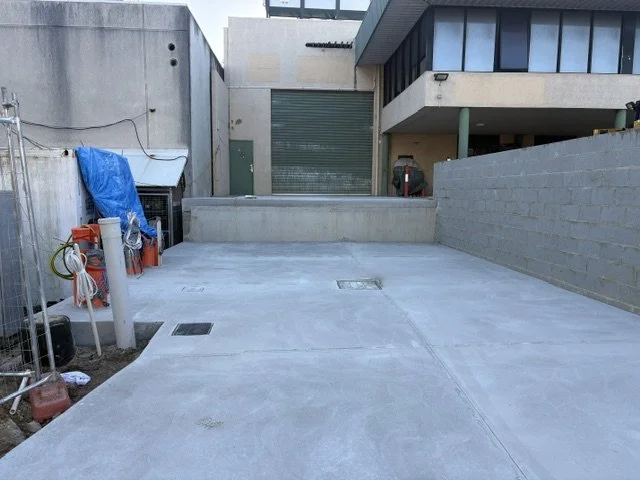

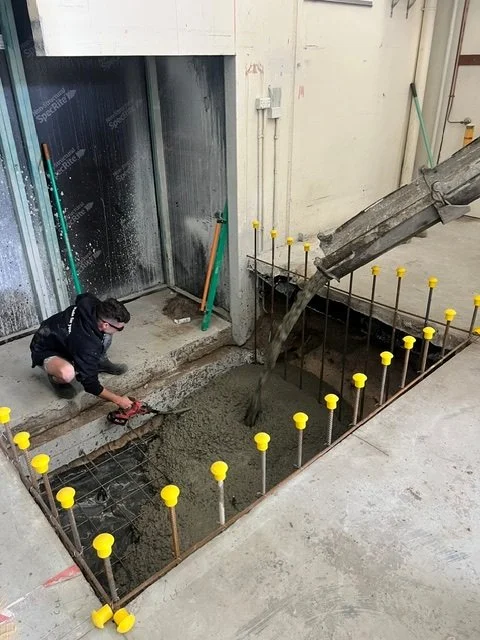

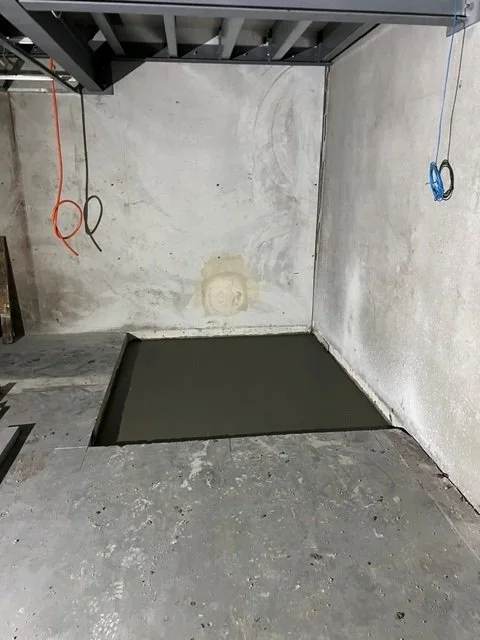

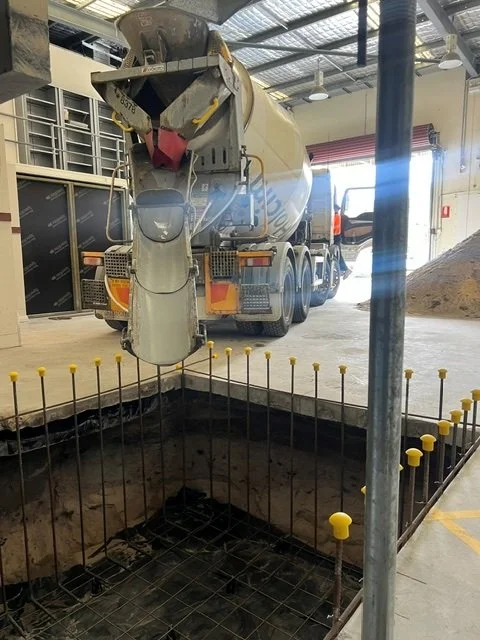

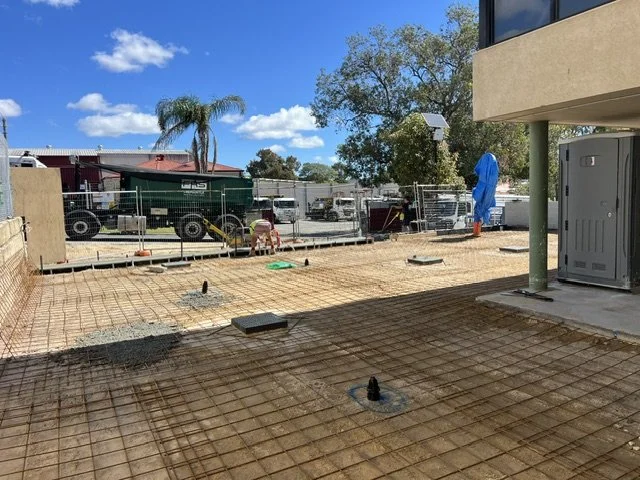

The footing for the loading dock has now been poured.
We are currently waiting for the bricklayer to complete the retaining walls adjacent to the loading dock, which is scheduled to occur during the coming week.
The concreters are booked for the following week to commence forming and pouring the concrete retaining walls. Shortly thereafter, works will commence on the loading dock slab and associated driveway concrete.
Access Control

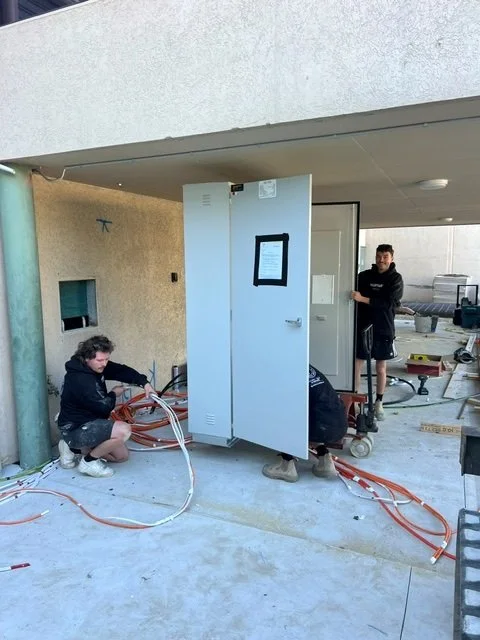

The access control design and coordination have now been finalised.
All required cabling has been pulled through within the CEO’s mezzanine and the areas below. Installation works are currently progressing beneath the mezzanine and will continue throughout the remainder of the facility over the coming weeks
Lots 111 – Documentation and Lift Coordination
Complete plans and construction details for Lots 111 remain outstanding. However, the proposed lift location has now been confirmed.
The area designated for the lift has been hoarded off, and the required floor cut-out works have been incorporated into the construction programme.
Once the remaining plans and details are received, we will be able to progress the associated works.
Lot 112 – Documentation and Programme
We have now received further documentation and plans for Lot 112, allowing the construction programme for this area to be developed.
Subject to the remaining information and trade availability, we are aiming to commence works during the final week of July or in early August.
Updated cost to complete
Updated costs to complete have been provided to Kraig. Please note that these figures do not include Architect or consultant fees or costs associated with Lot113
We are waiting for Kraig to review and document the original scope before we are able to formally document the variations
We have received further drawings and details from the architect and engineers for Lots 110 and 112. These details can now be issued to the relevant contractors for pricing, which will allow us to obtain updated quotes and develop a clearer cost-to-complete position for the remaining works.
-
Provided by Site Supervisor Greg Dowse
Awaiting critical design and documentation including:Substation building design
Ongoing incomplete and delayed documentation is impacting:
Programme certainty
Cost-to-complete accuracy
Still awaiting final structural and updated architectural drawings for the remaining Lots.
Ongoing uncertainty surrounding Western Power requirements, combined with limited communication and the lack of confirmed plans/documentation, continues to create significant programming challenges.
This uncertainty is impacting our ability to effectively plan, coordinate, and schedule upcoming construction activities,
This has will result in delays to the overall programme
Client has added additional scope for solar power, batteries and connection of Generators
as a result timelines and budgets will need to be re addressed
As the project has progressed, a number of changes, design developments, and unforeseen complexities have arisen.
These have naturally impacted both the project programme and overall budget.
As a result, the original timeline will require review and adjustment,
The associated cost implications will need to be addressed to accurately reflect the current project scope and delivery requirements.
As stated above, a particular concern is the potential cost increase due to the nature of the project.
Building while design and documentation remain incomplete has had, and will likely continue to have, a significant adverse impact on both the budget and timeline.
-
Provided by Site Supervisor Greg Dowse
Electrical pre-lay works ongoing, with updated pricing received in line with revised drawings.
Earthworks and Electrical pre lay
Earthworks and trenching are well underway at Freshfields Lot 110.
The civil contractors have been working closely with the electricians, with conduits now laid and cables pulled through to the required locations.
Backfilling will commence following completion of these works, and we are now awaiting the arrival of the electrical boards.
Retaining walls and footings
A concreter has been booked to commence during the week of 13 July to complete the footings for the retaining walls on the eastern and western sides.
Following completion of the footings, the bricklayers are booked for the following week to commence the blockwork for the retaining walls.
Internal Linings and Finishes in the CEO’s Mez
Gyprocking to the CEO’s mezzanine has now been completed, including all ceiling areas.
The air conditioning contractor has attended site to complete the required cut-outs, with the plumber and electricians also completing their cut-outs. We have also confirmed with the security contractor, who will attend site to complete his required cut-outs.
Subject to completion of these final service cut-outs, the painters have been booked to commence week starting 13 July.
Stair Demolition

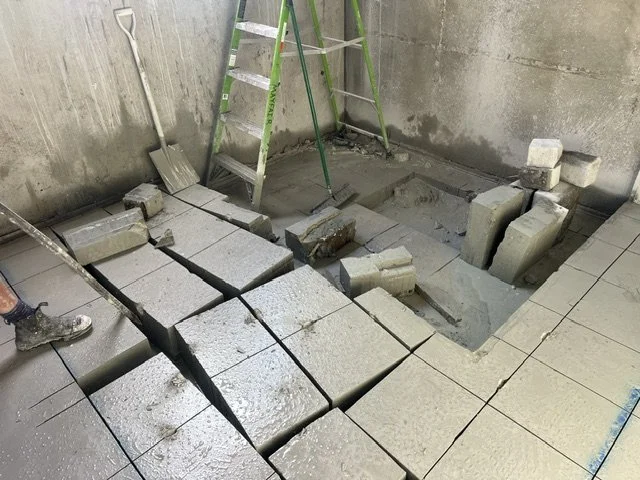

The existing concrete stairs at the front of Lot 110 have now been removed on both sides.
The area has been measured, and the concrete cutting contractor has been arranged to attend over the next few days to widen the suspended slab as required
Once this is complete, the new stair materials are ready, and construction of the new stairs will commence.

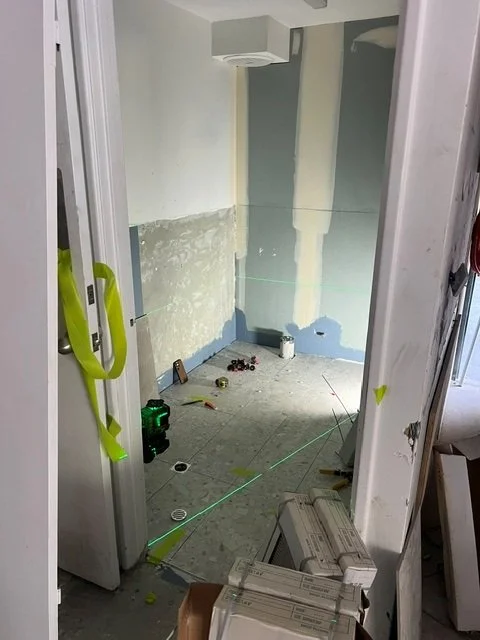

Tiling of staff bathrooms.
Due to the demolition of the existing concrete stairs and the construction of the new timber stairs, there will be some impact to the bathroom ceiling areas where the new stair structure encroaches.
As a result, tiling has been delayed by a further week to allow the new stairs to be constructed and the required bulkheads to be installed. Once these works are complete, tiling can commence.
Loading dock and Excavation works

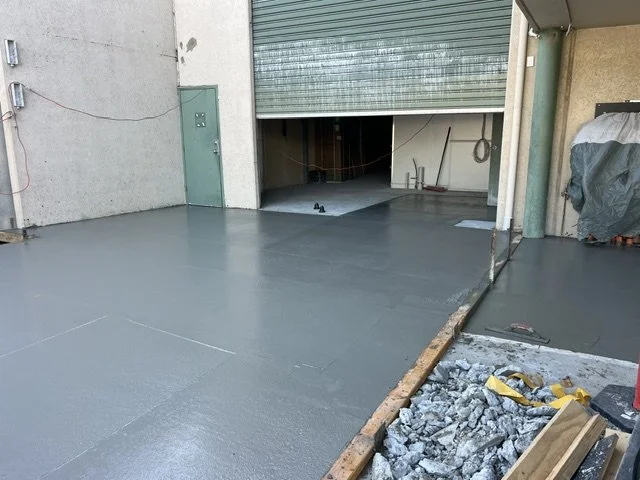

Loading dock works, site levels and excavation works are well underway.
A section of the retaining wall between Lots 110 and 111 has now been removed. The team is currently preparing for backfilling, along with the final excavation works required for the drainage tanks.
Once these works are complete, the retaining wall blockwork can commence.
Access Control
Access control coordination is still causing some delay. The drawings and locations have now been finalised; however, the contractor has not yet been able to attend site to complete the required review and mark-out.
As a result, painting has been pushed back by one week to allow the access control works to be properly coordinated before finishes commence.
Updated cost to complete
Updated costs to complete have been provided to Kraig. Please note that these figures do not include Architect or consultant fees
We are waiting for Kraig to review and document the original scope before we are able to formally document the variations
We have received further drawings and details from the architect and engineers for Lots 110 and 112. These details can now be issued to the relevant contractors for pricing, which will allow us to obtain updated quotes and develop a clearer cost-to-complete position for the remaining works.
-
Provided by Site Supervisor Greg Dowse
Awaiting critical design and documentation including:
Substation building design
Ongoing incomplete and delayed documentation is impacting:
Programme certainty
Cost-to-complete accuracy
Still awaiting final structural and updated architectural drawings for the remaining Lots.
Ongoing uncertainty surrounding Western Power requirements, combined with limited communication and the lack of confirmed plans/documentation, continues to create significant programming challenges.
This uncertainty is impacting our ability to effectively plan, coordinate, and schedule upcoming construction activities,
This has will result in delays to the overall programme
Client has added additional scope for solar power, batteries and connection of Generators
as a result timelines and budgets will need to be re addressed
As the project has progressed, a number of changes, design developments, and unforeseen complexities have arisen.
These have naturally impacted both the project programme and overall budget.
As a result, the original timeline will require review and adjustment,
The associated cost implications will need to be addressed to accurately reflect the current project scope and delivery requirements.
As stated above, a particular concern is the potential cost increase due to the nature of the project.
Building while design and documentation remain incomplete has had, and will likely continue to have, a significant adverse impact on both the budget and timeline.
-
Provided by Site Supervisor Greg Dowse
Electrical pre-lay works ongoing, with updated pricing received in line with revised drawings.
Cabinetry has been manufactured,
Waiting on the completion of works before final instillation in CEO’s Mez
Appliances have been ordered and a number of items have arrived
Additional mezzanines flooring has been completed.
Gyprock installation in the CEO’s Mez will commence next week this includes the ceiling.
Framing for the ceiling underneath the CEO’s Mez has commenced
Air conditioning installation has been completed, waiting on Ceiling to be installed
Assessment of the building stairs and access requirements has now been completed.
Findings indicate that the staircase to both buildings will need demolished and rebuilt. I have arranged for demolition to commence next week
This unfortunately has resulted in having to push back the Tiler as the demolition will impact the downstairs bathroom
Renovation works to the three additional staff bathrooms have now commenced.
Tiles have been delivered Tiling has been pushed back two weeks.
Site levels and height assessments for the loading dock and crossover have now been completed.
All services have now been cut
We are currently excavating Loading dock and Loading ramp
The client has requested alternative access control and security consultants for the project.
We have finally received quotes relating to this scope of works.
We are working with the Contractor to understand the costs and details.

Earthworks have commenced
The driveway has been pulled up.
Soak wells have been installed.
We are currently working on removing concrete in the under croft as well as removing the retaining walls between the Lot 110 and 111
Next week we will begin trenching and installing electrical cables
Updated cost to complete has been provided to Kraig. Please note that these figures do not include Architect or consultant fees
Kraig to review and document the original scope before we are able to formally document the variations
-
Provided by Site Supervisor Greg Dowse
Awaiting critical design and documentation including
Ongoing incomplete and delayed documentation is impacting:
Programme certainty
Cost-to-complete accuracy
Still awaiting final structural and updated architectural drawings for the remaining Lots.
Ongoing uncertainty surrounding Western Power requirements, combined with limited communication and the lack of confirmed plans/documentation, continues to create significant programming challenges.
This uncertainty is impacting our ability to effectively plan, coordinate, and schedule upcoming construction activities,
This has will result in delays to the overall programme
Client has added additional scope for solar power, batteries and connection of Generators
as a result timelines and budgets will need to be re addressed
As the project has progressed, a number of changes, design developments, and unforeseen complexities have arisen.
These have naturally impacted both the project programme and overall budget.
As a result, the original timeline will require review and adjustment,
The associated cost implications will need to be addressed to accurately reflect the current project scope and delivery requirements.
As stated above, a particular concern is the potential cost increase due to the nature of the project.
Building while design and documentation remain incomplete has had, and will likely continue to have, a significant adverse impact on both the budget and timeline.
-
Provided by Site Supervisor Greg Dowse
All trades inducted; site protocols and emergency procedures communicated.
Electrical pre-lay works ongoing, with updated pricing received in line with revised drawings.
Cabinetry has been manufactured,
CEO’s vanity has been installed
Kitchenette in the office has been installed
Waiting on the completion of works before final instillation in CEO’s Mez
Appliances have been ordered and a number of items have arrived
Epoxy flooring contractors completed Stage 1 works,
Condenser units have been delivered and have now been lifted onto roof.
Additional mezzanines flooring has been completed.
Gyprock installation Studd walls and frame works have started in the additional Mez we are about 80% complete These works are currently awaiting installation of security cabling before the ceiling can be installed.
Framing for the ceiling underneath the CEO’s Mez has commenced
Air conditioning installation has been completed, waiting on Ceiling to be installed
Updated cost to complete has been provided to Kraig. Please note that these figures do not include Architect or consultant fees
We are waiting for Kraig to review and document the original scope before we are able to formally document the variations
Renovation works to the three additional staff bathrooms have now commenced.
Demolition works to all bathroom areas have been completed.

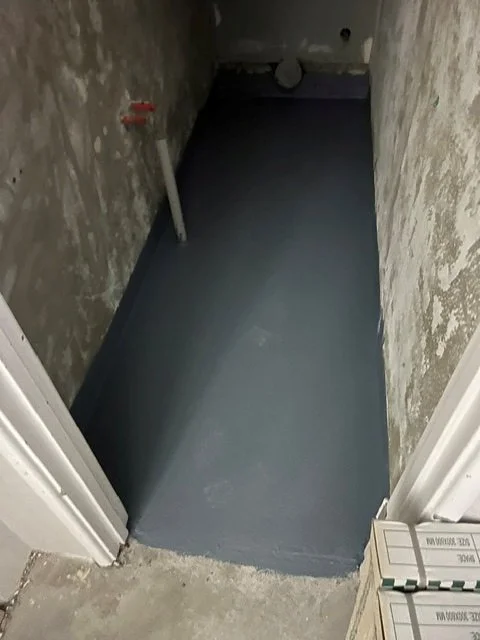

Plumbing pre-lay works are complete.
Locations for all hot water systems have now been finalised and completed.
Tiles have been delivered and Tiler booked for 15 June
Assessment of the building stairs and access requirements has now been completed.
Findings indicate that the staircase to one of the buildings will need demolished and rebuilt I have arranged for demolition to commence next week
Site levels and height assessments for the loading dock and crossover have now been completed.
All services have now been cut
The client has requested alternative access control and security consultants for the project.
An additional consultant has now been engaged,
multiple site meetings have been held to review the existing plans, layouts, and project requirements.
We are currently awaiting updated pricing and recommendations, which are expected to be received within the next two weeks.
This is causing significant delays to being able to complete the CEO’s Mez
Lift Shaft on the ground floor has been cut out for CEO’s Mez .
Steel has been Installed
Bitumen along perimeter of concrete driveway has been removed
Grout injection has been completed along perimeter of driveway.

Earthworks have commenced
The driveway is currently being pulled up.
Soak wells have been ordered and will be installed next week
Western power has de powered site.

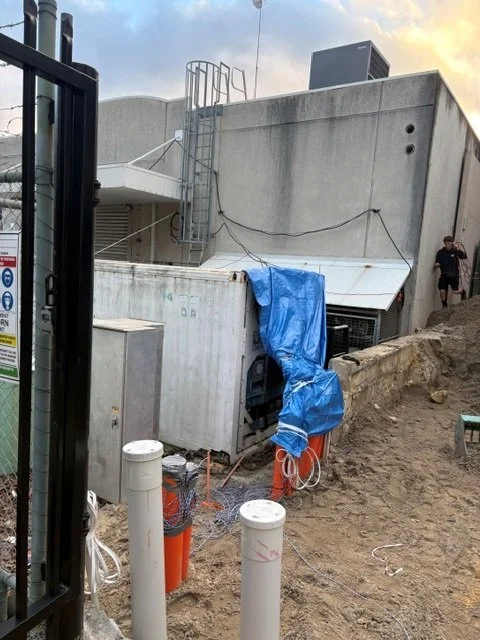

Generator and fuel supply tank is on site powering cold room containers.
-
Provided by Site Supervisor Greg Dowse
Awaiting critical design and documentation including:
Access control details (currently delaying finishing to CEO’s Mez)
Substation building design
Ongoing incomplete and delayed documentation is impacting:
Programme certainty
Cost-to-complete accuracy
Still awaiting final structural and updated architectural drawings for the remaining Lots.
Ongoing uncertainty surrounding Western Power requirements, combined with limited communication and the lack of confirmed plans/documentation, continues to create significant programming challenges.
This uncertainty is impacting our ability to effectively plan, coordinate, and schedule upcoming construction activities,
This has will result in delays to the overall programme
Client has added additional scope for solar power, batteries and connection of generators
As a result timelines and budgets will need to be re addressed
As the project has progressed, a number of changes, design developments, and unforeseen complexities have arisen.
These have naturally impacted both the project programme and overall budget. As a result, the original timeline will require review and adjustment. The associated cost implications will need to be addressed to accurately reflect the current project scope and delivery requirements.
As stated above, a particular concern is the potential cost increase due to the nature of the project.
Building while design and documentation remain incomplete has had, and will likely continue to have, a significant adverse impact on both the budget and timeline.
-
Provided by Site Supervisor Greg Dowse
All trades inducted; site protocols and emergency procedures communicated.
Electrical pre-lay works ongoing, with updated pricing received in line with revised drawings.
Cabinetry can now start to be manufactured,
CEO’s Vanity has been installed
Kitchenette in the office due to be installed 28th of May
Appliances have been ordered
Epoxy flooring contractors have been on site over the past week and have completed Stage 1 works, including all refrigeration panel areas.
Epoxy flooring installation has progressed well, and the completed areas are presenting to a high standard.
Condenser units have been delivered and have now been lifted onto roof.
Additional mezzanines flooring has been completed.
Gyprock installation Studd walls and frame works have started in the additional Mez we are about 80% complete
Air conditioning installation has been completed, waiting on Ceiling to be installed
Updated cost to complete has been provided to Kraig
Renovation works to the three additional staff bathrooms have now commenced.
Demolition works to all bathroom areas have been completed.
Plumbing pre-lay works are currently underway.
Locations for all hot water systems have now been finalised and completed.
Tiles have been delivered and Tiler booked for 15 June
Assessment of the building stairs and access requirements has now been completed.
Findings indicate that the staircase to one of the buildings will lneed demolished and rebuilt
Site levels and height assessments for the loading dock and crossover have now been completed. Existing power, Telstra, and gas services have been identified running through the crossover area. Current assessment drawings indicate that these services are approximately 1.5m deep. Based on current site assessments, it appears that only approximately 500mm of excavation may be required, which could eliminate the need to disconnect existing services and provide a significant time saving to the programme. Radar surveyors have also been engaged to undertake detailed service locating and depth verification at 500mm intervals across the crossover to minimise risk during excavation works.
The client has requested alternative access control and security consultants for the project. An additional consultant has now been engaged, and multiple site meetings have been held to review the existing plans, layouts, and project requirements. We are currently awaiting updated pricing and recommendations, which are expected to be received within the next two weeks. This is causing delays to being able to complete the CEO’s Mez
Lift Shaft has not been cut out for CEO’s Mez.
Steel has been ordered for Lift shaft and Staircase. To go into the CEO’s Mez, due to be installed 29th May
Bitumen along perimeter of concrete driveway has been removed
Grout injection has been completed along perimeter of driveway.
Earthworks to commence 2nd of June
Driveway to be pulled up,
Soak wells have been ordered and will put installed in the next 3 weeks
Western power has de powered site.
Generator and fuel supply tank is on site powering cold room containers.
-
Provided by Site Supervisor Greg Dowse
Awaiting critical design and documentation including:
Access control details (currently delaying finishing to CEO’s Mez)
Substation building design
Ongoing incomplete and delayed documentation is impacting:
Programme certainty
Cost-to-complete accuracy
Still awaiting final structural and updated architectural drawings for the remaining Lots.
Ongoing uncertainty surrounding Western Power requirements, combined with limited communication and the lack of confirmed plans/documentation, continues to create significant programming challenges. This uncertainty is impacting our ability to effectively plan, coordinate, and schedule upcoming construction activities, with the potential to cause delays to the overall programme.
As the project has progressed, a number of changes, design developments, and unforeseen complexities have arisen. These have naturally impacted both the project programme and overall budget. As a result, the original timeline will require review and adjustment, and the associated cost implications will need to be addressed to accurately reflect the current project scope and delivery requirements.
-
Provided by Site Supervisor Greg Dowse
All trades inducted; site protocols and emergency procedures communicated.
Electrical pre-lay works ongoing, with updated pricing received in line with revised drawings.
Cabinetry can now start to be manufactured
Appliances have been ordered
Epoxy flooring contractors have been on site over the past week and a half and have completed Stage 1 works, including all refrigeration panel areas.
Epoxy flooring installation has progressed well, and the completed areas are presenting to a high standard.
Met on site with the structural engineer and Brett from Arcus to review roof plant locations.
Condenser unit locations have now been marked out within the roof space for structural assessment purposes.
Jason is currently completing the structural assessment and preparing the required drawings/details for installation.
Arcus is ready to proceed with installation of the rooftop condensers once final structural approval and drawings are issued.
Additional mezzanines flooring has been completed.
Gyprock installation Studd walls and frame works have started in the additional Mez
Air conditioning shop drawings have now been reviewed and signed off by the engineers.
Air conditioning installation has been scheduled to commence following completion of gyprocking works and ceiling framework installation.
Updated cost to complete has been provided to Kraig
Renovation works to the three additional staff bathrooms have now commenced.
Demolition works to all bathroom areas have been completed.
Plumbing pre-lay works are currently underway.
Locations for all hot water systems have now been finalised and completed.
Assessment of the building stairs and access requirements has now been completed.
Findings indicate that the staircase to one of the buildings will likely need to be widened to meet access requirements.
Current investigations are focused on determining whether the existing staircase can be extended/modified rather than fully demolished and replaced.
Further discussions and assessment are ongoing to determine the most practical and cost-effective solution.
Site levels and height assessments for the loading dock and crossover have now been completed. Existing power, Telstra, and gas services have been identified running through the crossover area. Current assessment drawings indicate that these services are approximately 1.5m deep. Based on current site assessments, it appears that only approximately 500mm of excavation may be required, which could eliminate the need to disconnect existing services and provide a significant time saving to the programme. Radar surveyors have also been engaged to undertake detailed service locating and depth verification at 500mm intervals across the crossover to minimise risk during excavation works.
The client has requested alternative access control and security consultants for the project. An additional consultant has now been engaged, and multiple site meetings have been held to review the existing plans, layouts, and project requirements. We are currently awaiting updated pricing and recommendations, which are expected to be received within the next two weeks.
-
Provided by Site Supervisor Greg Dowse
Awaiting critical design and documentation including:
Access control details
Power- Western power instillation schedule etc
Structural drawings ( weight of Plant on roof )
Substation building design
Electrical and lift documentation
Ongoing incomplete and delayed documentation is impacting:
Programme certainty
Cost-to-complete accuracy
Still awaiting final structural and updated architectural drawings.
Ongoing uncertainty surrounding Western Power requirements, combined with limited communication and the lack of confirmed plans/documentation, continues to create significant programming challenges. This uncertainty is impacting our ability to effectively plan, coordinate, and schedule upcoming construction activities, with the potential to cause delays to the overall programme.
-
Provided by Site Supervisor Greg Dowse
All trades inducted; site protocols and emergency procedures communicated.
Arcus has completed their refrigeration panels as well as installed several internal condensers.
Epoxy flooring and screed works are scheduled to commence Tuesday and are expected to take approximately two weeks.
Copper pipework installation has completed
Electrical pre-lay works ongoing, with updated pricing received in line with revised drawings.
Met with concreter and mechanical contractor to obtain updated quotations.
Tiling contractor has completed bathroom
Cabinetry can now start to be manufactured
Appliances have been ordered
The air-conditioning contractor has completed drawings and is awaiting installation.
Additional mezzanines have been completed, with flooring scheduled for completion early next week.
Gyprock installation is scheduled to commence Wednesday.
Updated cost to complete has been provided to Kraig
-
Provided by Site Supervisor Greg Dowse
Awaiting critical design and documentation including:
Access control details
Structural drawings ( weight of Plant on roof )
Substation building design
Electrical and lift documentation
Ongoing incomplete and delayed documentation is impacting:
Programme certainty
Cost-to-complete accuracy
Still awaiting final structural and updated architectural drawings.
Western Power currently providing provisional power only, posing a potential constraint to upcoming works.
-
Provided by Site Supervisor Greg Dowse
All trades inducted; site protocols and emergency procedures communicated.
Arcus have completed approximately 50% of freezer panel installation.
Copper pipework installation has commenced.
Electrical pre-lay works ongoing, with updated pricing received in line with revised drawings.
Met with concreter and mechanical contractor to obtain updated quotations.
Core holes completed.
All internal concrete formed and poured.
North Star Security have decommissioned existing system; design underway for replacement system.
Ceiling works: tiled ceilings removed, new ceiling grid installed, bathrooms completed.
Tiling contractor has commenced waterproofing works.
-
Provided by Site Supervisor Greg Dowse
Awaiting critical design and documentation including:
Access control details
Structural drawings ( weight of Plant on roof )
Substation building design
Electrical and lift documentation
Ongoing incomplete and delayed documentation is impacting:
Programme certainty
Cost-to-complete accuracy
Still awaiting final structural and updated architectural drawings.
Western Power currently providing provisional power only, posing a potential constraint to upcoming works.
-
Provided by Site Supervisor Greg Dowse
Inducted all trades to site and ensured they are aware of all emergency procedures and site protocols.
Arcus has commenced installation of the refrigeration panels for the freezer.
Electrical pre-lay works have continued throughout the building, and updated quotes have been received to align with plan revisions.
Measured up and marked out electrical points in CEO’s Mez for Kitchen and Wardrobes
Arranged installation of part of the mezzanine floor in 110B to allow refrigeration pipework to be run.
Scheduled the core hole contractor to attend site and complete penetrations required for pipework.
Concrete is scheduled to be poured on Saturday beneath the CEO’s mezzanine in 110A, as well as part of 110B.
Met with Chris Steel from Specialised Building Solutions and am awaiting further information to progress a number of items.
Met with Northstar Security to review the scope of works and am currently awaiting their detailed plan and quotation.
Received all required Gyprock quotes for the extensions.
Continued development of detailed scopes of work across Lots 110A and 110B.
Met with Gate contractor, walked through the scope of work waiting on quote.
-
Provided by Site Supervisor Greg Dowse
Awaiting further information relating to access control, structural drawings for footings and retaining walls, substation building details, electrical, lifts and other key design elements.
Incomplete documentation and delayed decisions will inevitably impact project commencement and completion.
This is also limiting the ability to finalise an accurate cost-to-complete.
Still awaiting completed hydraulic, structural, mechanical and updated architectural drawings.
-
Provided by Site Supervisor Greg Dowse
Continued progress with putting together a scope of works over the 3 areas that comprise Lot 110- Grahams Mez, IT office and Hall and Prior operations
Continued progress with pricing, I have met with several contractors out on site to quote on the job.
However, we are still waiting on Hydraulic, structural, and Mechanical plans including updated Architectural plans.
TO COME
Materials for Grahams bathroom have begun to arrive i.e. Tiles and bathroom fixtures.
Nikolas has started inventorying all signage and safety equipment on site. We've identified signage placements and established a site office. Next week, he will return to complete the site safety setup.
We expect to receive the hydraulic drawings early next week. Once received, our plumbing team can complete their quotes, and we can develop a more defined scope and timeline.
-
Provided by Site Supervisor Greg Dowse
Incomplete plans will inevitably cause delays in both the start and completion of the project.
We are awaiting clarification on multiple cost-related items, which impacts the availability of appliances, materials, and equipment.
Highly complex Hydraulic and Electrical program
SITE PHOTOS
Site Progress | 17 July 2026
Pre-lay Works | 3 July 2026
Soak Well Install | 19 June 2026
Electrical Works with Hughes Electrical Group
RENDERS, SELECTIONS & PROJECT DOCUMENTS
Proposed Alterations Lot 110
Proposed Alterations Lot 111
Proposed Alterations Lot 112
Proposed Alterations Lot 113
Project Summary Checklist
For an extensive overview of renders, selections and project please view here (link to Sharepoint)
