MAYFAIR STREET, WA
PROJECT PORTAL
This private project portal is designed to provide clear, real-time visibility across each stage of Mayfair Street’s construction. Here you can access updates, timelines, documentation and site imagery all in one central, easy-to-navigate space.
YOUR PROJECT TEAM
Greg Dowse - Mayfair BC
greg@mayfairbc.au
0407 755 266
Site Supervisor
Client Communications
Lauren Gavriel - Mayfair BC
lauren@mayfairbc.au
0426 610 090
Jamie de Beaux - Maxi Projects
jd@maxipm.au
0410 524 862
Project Management
Kylene Tan - Mata Designs
kylene@matadesign.com.au
0437 618 616
Architecture & Interior Design
PROJECT UPDATES
Provided by Site Supervisor Greg Dowse
-
Provided by Site Supervisor Greg Dowse
All trades inducted; site protocols and emergency procedures communicated.
Structural steel

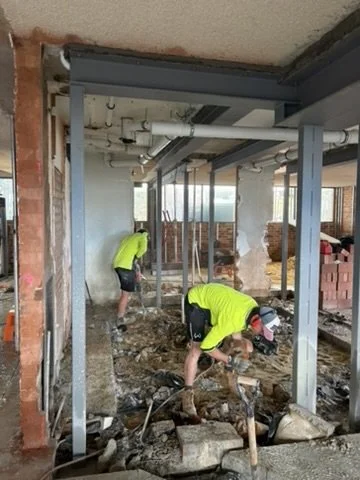

Structural grout between the steel beams has been completed
Bricklayers
Following the structural engineer’s site inspection, approval was provided to remove and relocate the remaining internal walls on the ground floor.
The walls have now been removed, and the bricklayer has completed approximately 75% of the downstairs brickwork. Additional sections of the floor slab were also cut out to allow the new brickwork to be constructed directly on the existing footings
We are still awaiting the structural engineer’s confirmation of the structural steel required to replace the support previously provided by the wall.
We anticipate that the remaining ground-floor brickwork will be completed early next week.
Plumbing

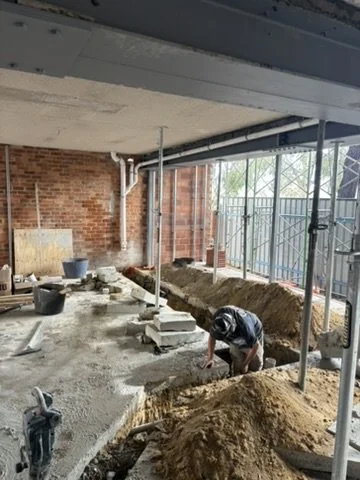

Good progress has been made on the plumbing pre-lay works this week. The pre-lay for Graeme’s ensuite is now complete, along with the required concrete cutting and plumbing pre-lay works throughout the ground floor and upper floor.
We are now waiting for the bricklayer to complete the remaining walls. Once complete, the ground-floor slab infills can be poured, allowing the downstairs framing to commence and the plumbers to proceed with the tube-out works.
Roof Extension

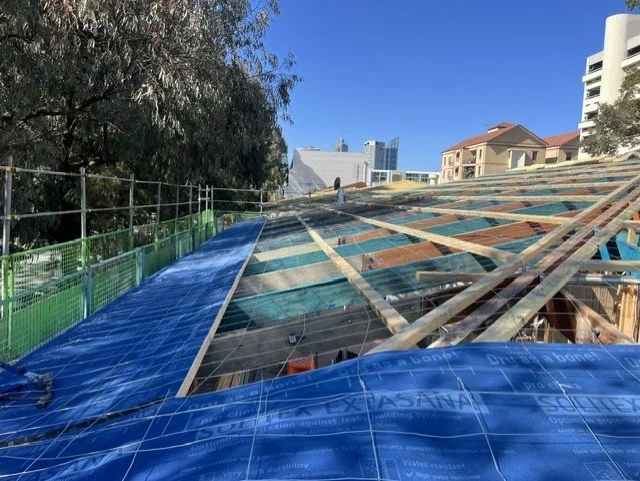

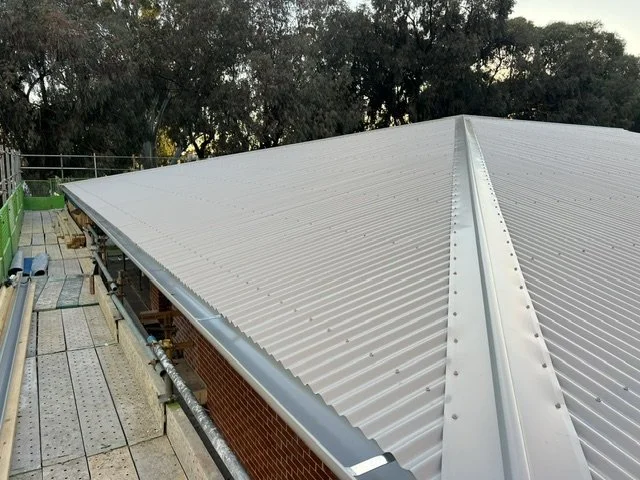

All materials required to complete the roof structure have now been received, and we have commenced the roof modification works.

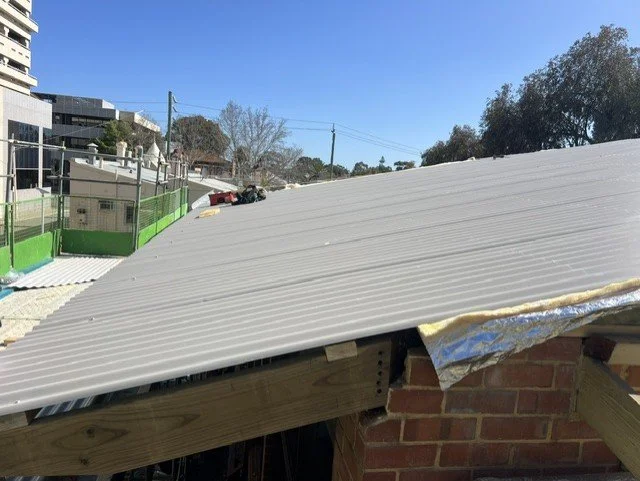

The existing roof sheets obstructing the works have been removed. Temporary tarps have been installed over the exposed areas to maintain weather protection while the works progress.
The roof coverings and gutter details have also been confirmed with the roof plumbing contractor, who remains booked to complete the roof sheeting during the second week of August.
Stormwater and Soakwells
As previously noted, no details were available confirming the existing stormwater system or the locations of the soakwells.
This week, a civil consultant attended site. We have completed camera inspections of the existing downpipes, drainage lines and soakwells across the facility. The consultant is now reviewing the findings and preparing recommendations for the required stormwater works.

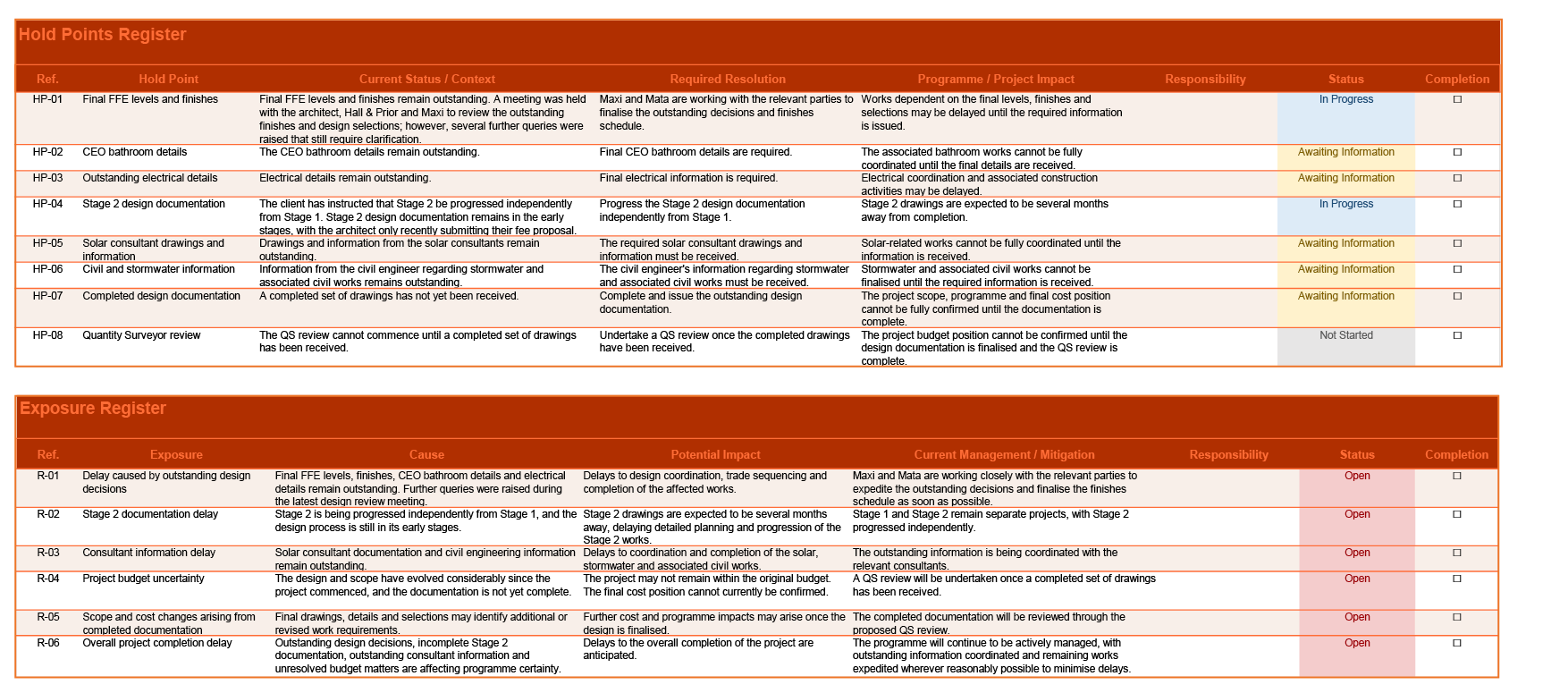

Programme and Trade Scheduling
Jamie, the newly appointed Project Manager from Maxi, has now been introduced to the project. We are working closely with Jamie to establish how our respective systems and processes can be effectively integrated for the remainder of the works.
The construction programme has now been developed as far as the currently available information allows. We have commenced sequencing the upcoming works, coordinating trade interfaces and confirming trade bookings in line with the programme.
-
Provided by Site Supervisor Greg Dowse
Awaiting on final FFE levels, finishes, CEO bathroom details outstanding electrical details
This week, we met with the architect, Hall & Prior and Maxi to review the outstanding finishes and design selections. Unfortunately, the meeting raised several further queries that still require clarification.
Maxi and Mata are now working closely with the relevant parties to expedite the outstanding decisions and finalise the finishes schedule as soon as possible.
Stage 1 and Stage 2 remain separate projects.
The architect has confirmed that the client has instructed that Stage 2 be progressed independently from Stage 1.
As a result, Stage 2 design documentation is still in the early stages, with the architect only recently submitting their fee proposal. Stage 2 drawings are therefore expected to be several months away from completion.
Waiting on drawings and information from
The solar consultants
Civil engineer regarding stormwater and associated civil works.

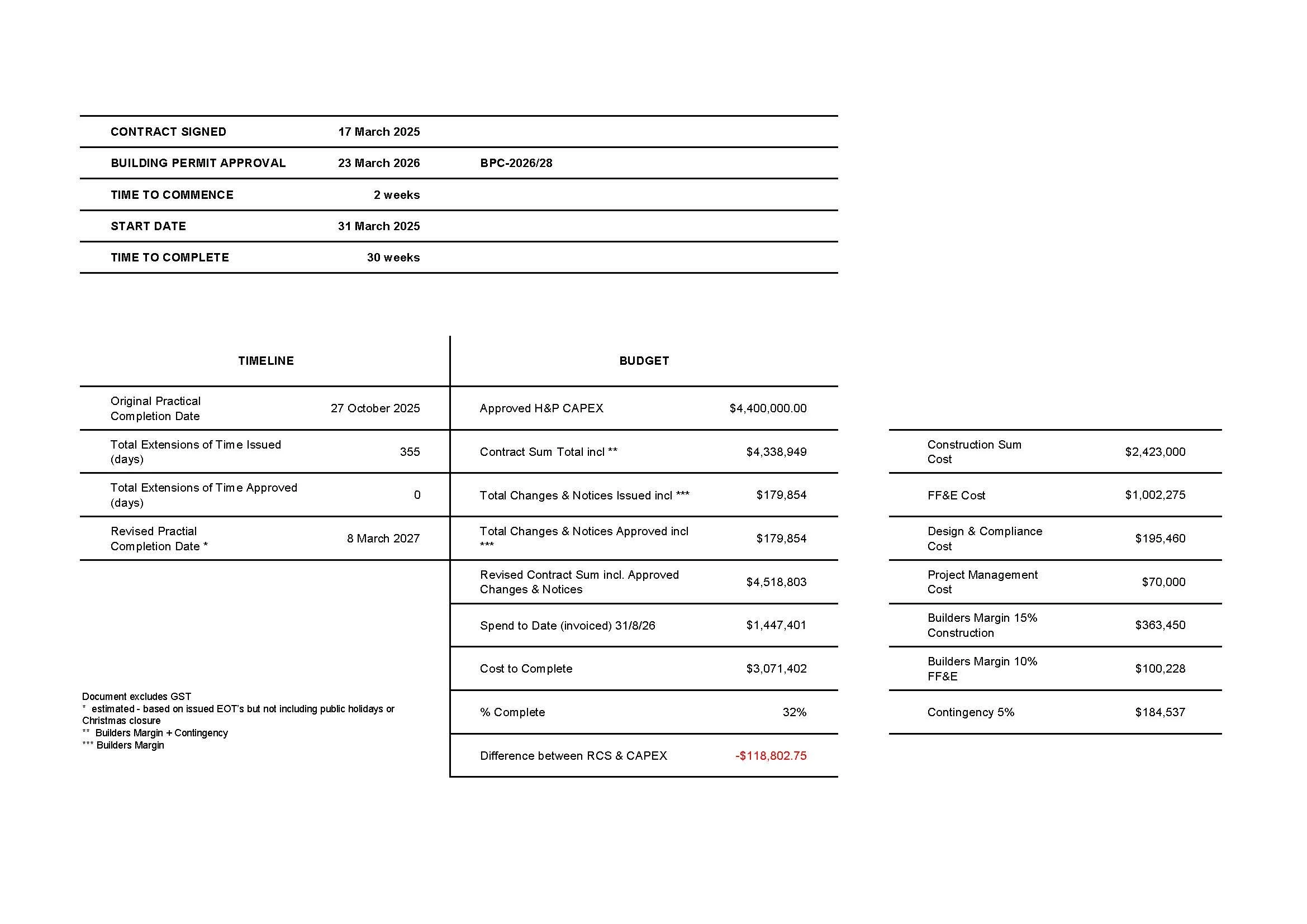

Project Budget Review

As the design and scope have evolved considerably since the project commenced, we have discussed with the team the need to undertake our own Quantity Surveyor (QS) review once a completed set of drawings has been received.
Until the design documentation is finalised and a QS review has been completed, we are unable to confirm whether the project will remain within the original budget.
Programme Impact
Due to the contributing factors outlined above, delays to the overall completion of the project are anticipated.
We will continue to actively manage the programme, coordinate the outstanding information, and expedite the remaining works wherever reasonably possible to minimise any delay.
-
Provided by Site Supervisor Greg Dowse
All trades inducted; site protocols and emergency procedures communicated.
Structural steel
Structural grout between the steel beams has been 90% completed
Bricklayers

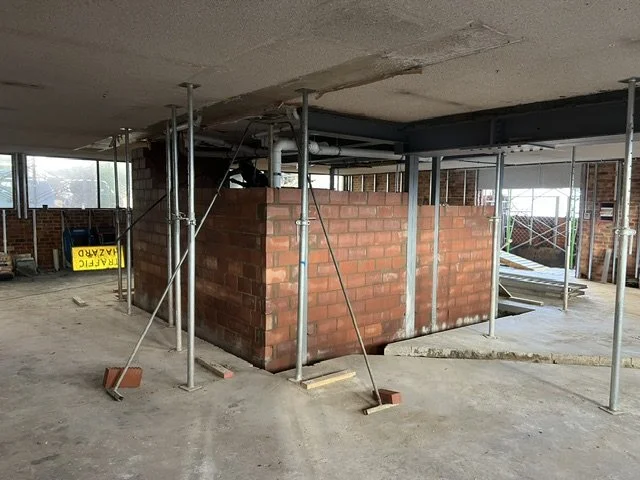

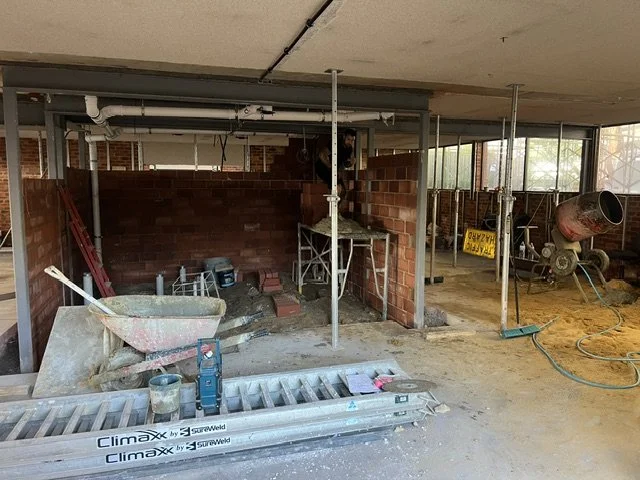

The bricklayers have completed the external skins around the eastern and western sides of the building. They are scheduled to commence the internal brickwork between the bathroom areas the week after next. Framework is well underway on the top floor
We have identified an issue with the existing north-south brick wall on the eastern side, which is not in the location shown on the current drawings. This impacts the service penetrations coming down through the suspended slab, as the wall is currently obstructing the proposed service runs.
We have met with the structural engineer on site and are awaiting his advice on whether additional roof steel will be required if the wall is relocated. Subject to confirmation from the engineer, the existing wall will be removed and rebuilt in the correct location in approximately two weeks.
Plumbing
We have received updated plans from the architect and engineer confirming the service locations for Graham’s ensuite.
The boundary wall backing onto Graham’s ensuite has now been removed. Plumbers are scheduled to commence next week to complete the core drilling and pre-lay works for Graham’s ensuite.

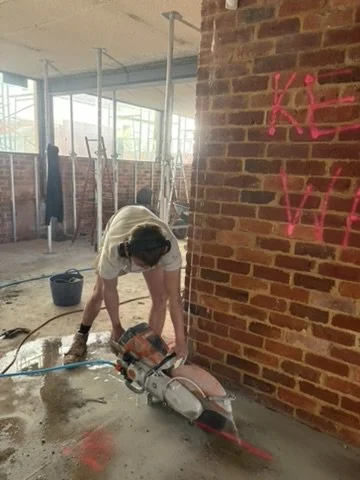

While on site, they will also complete the concrete cutting and pre-lay works required for the remaining downstairs bathrooms.

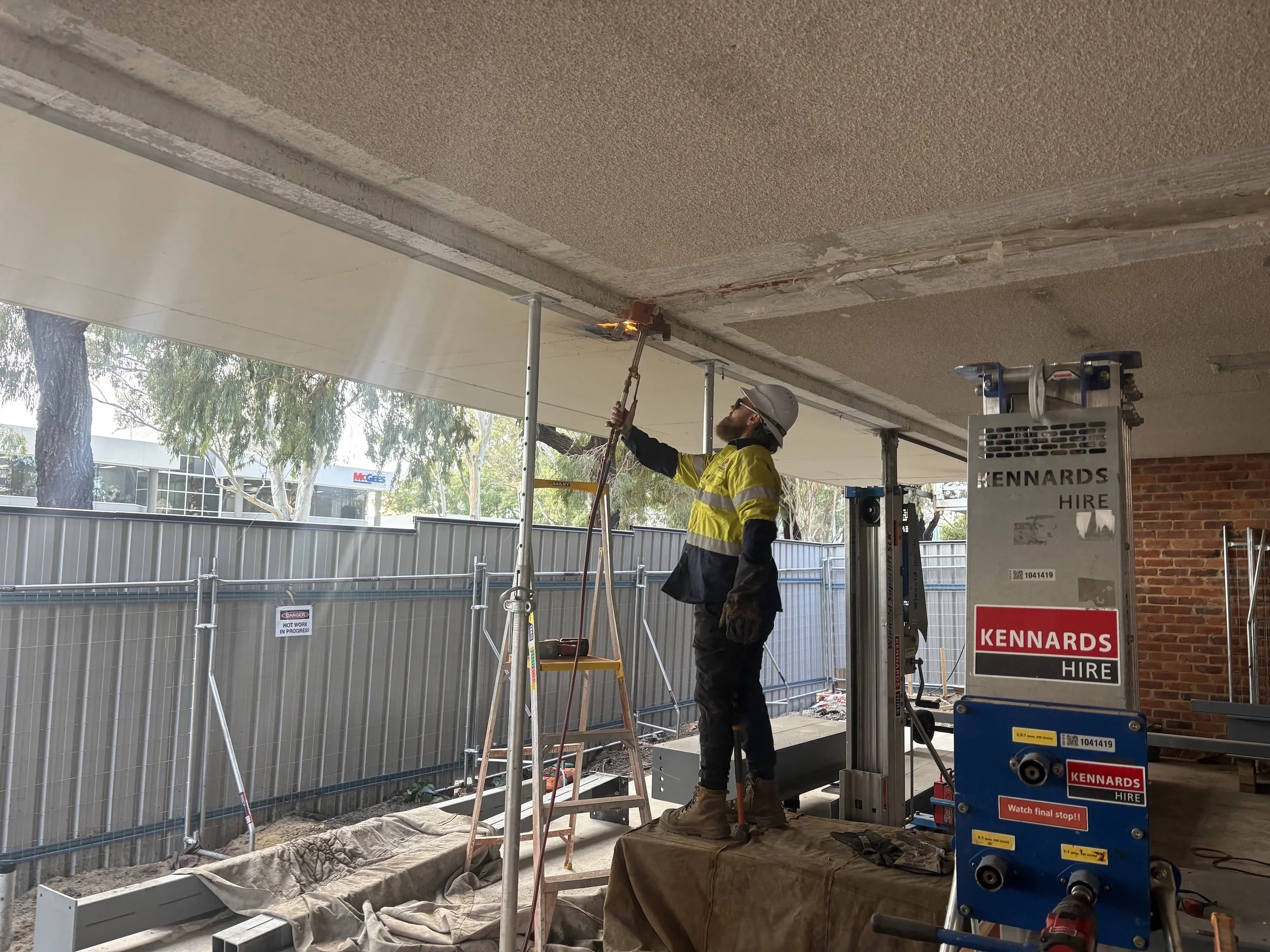

Roof Extension

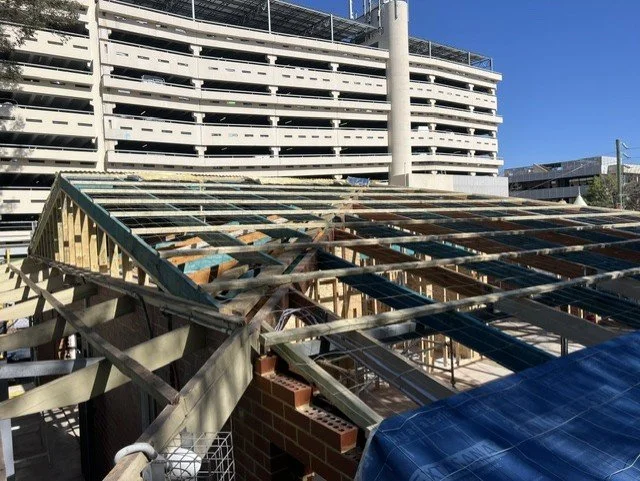

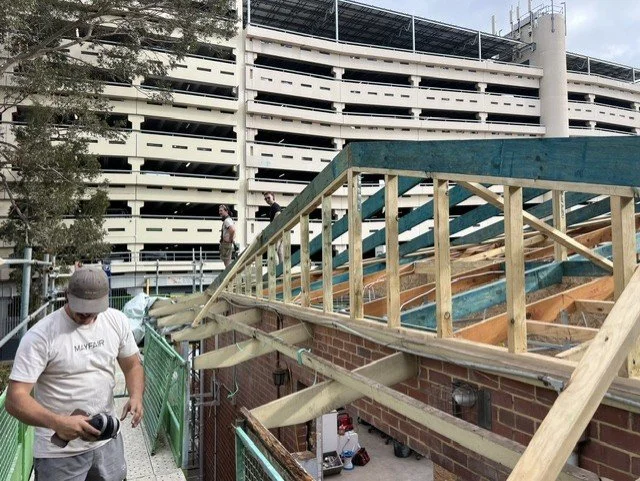

The structural engineer has attended site to review the roof extension and has now issued the required structural drawings.

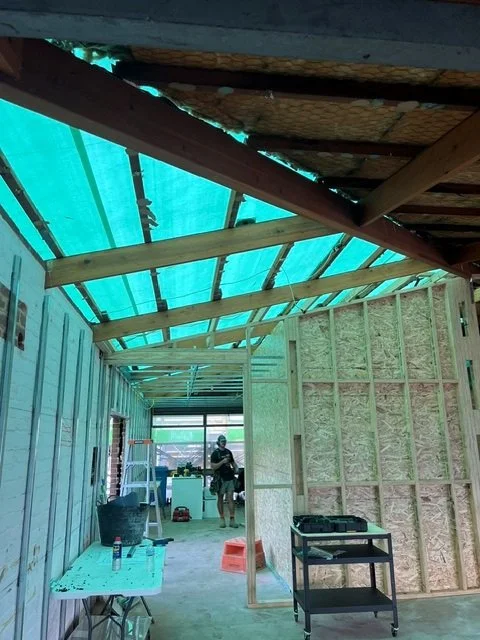

We have reviewed the drawings, confirmed the materials required, and placed the material orders. The roof plumbers have been booked to sheet the roof in the second week of August.

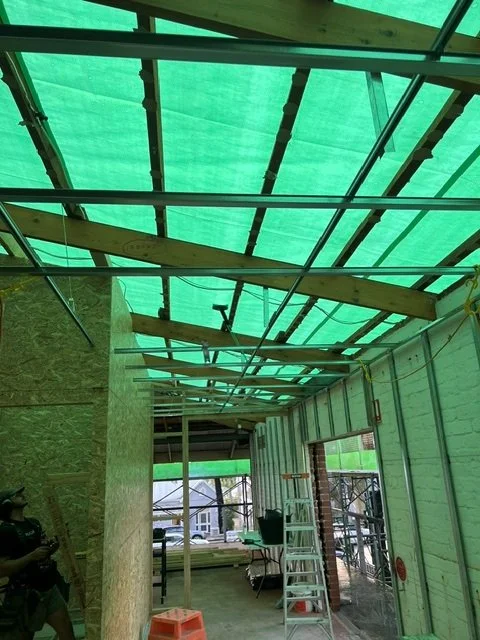

To align with this, we anticipate commencing the roof extension works approximately 7 to 10 days prior. While we are aiming to progress these works as soon as possible, the sequencing has been planned to minimise the period where the building is exposed and reliant on temporary tarping.

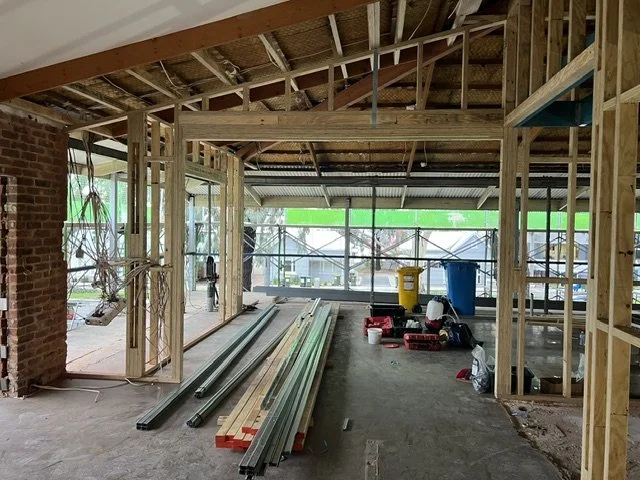

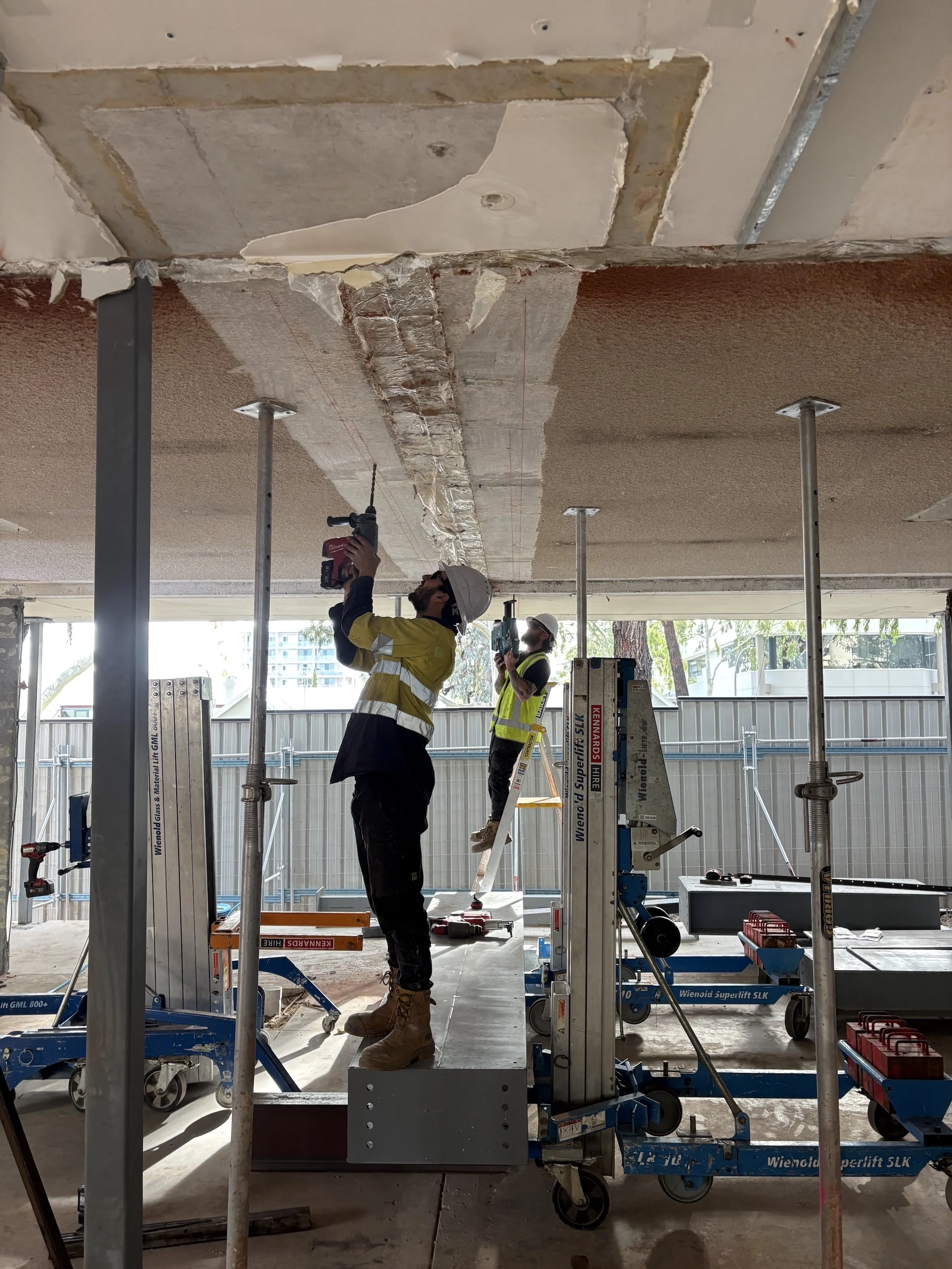

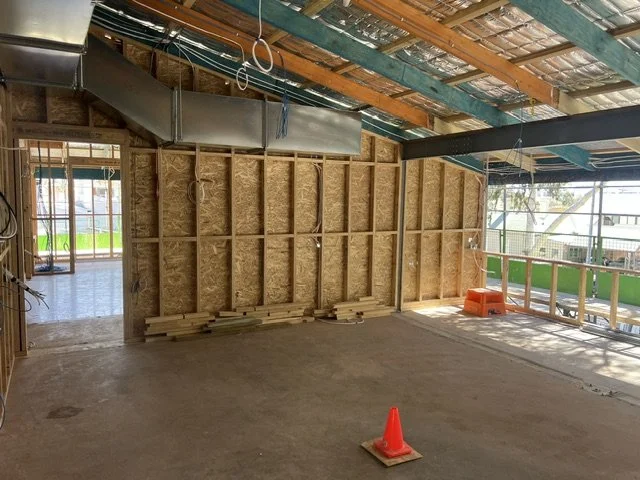

Internal Linings

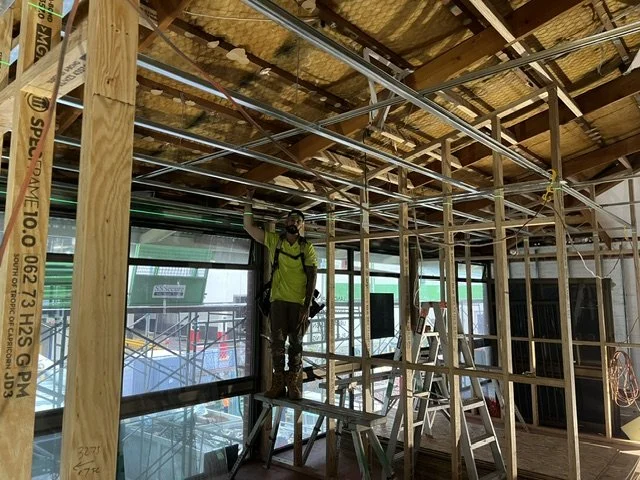

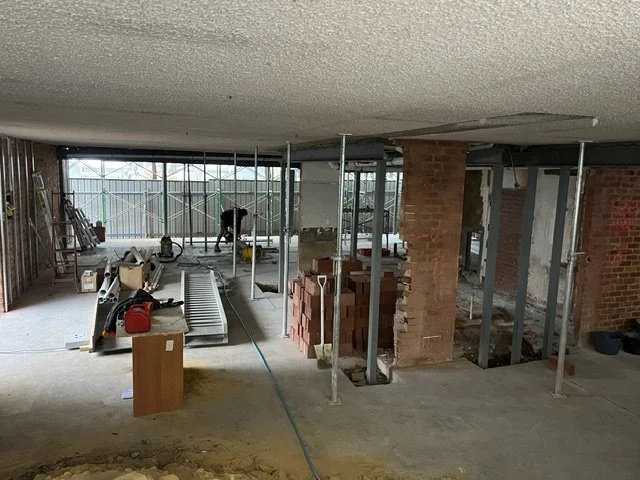

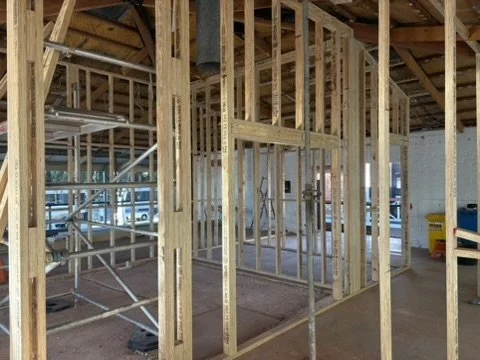

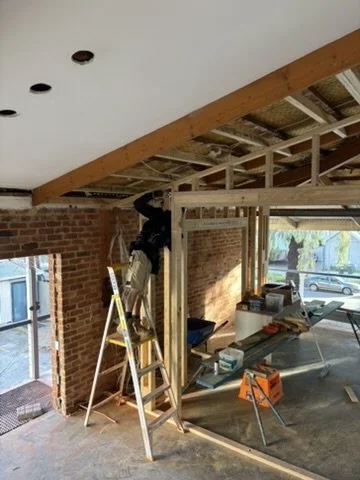

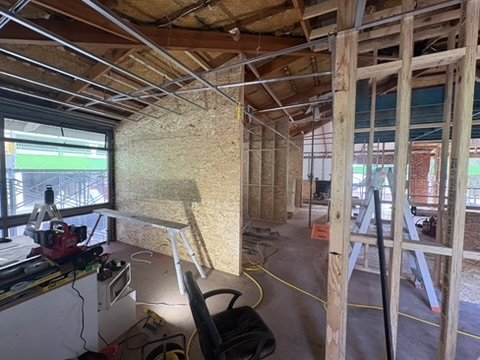

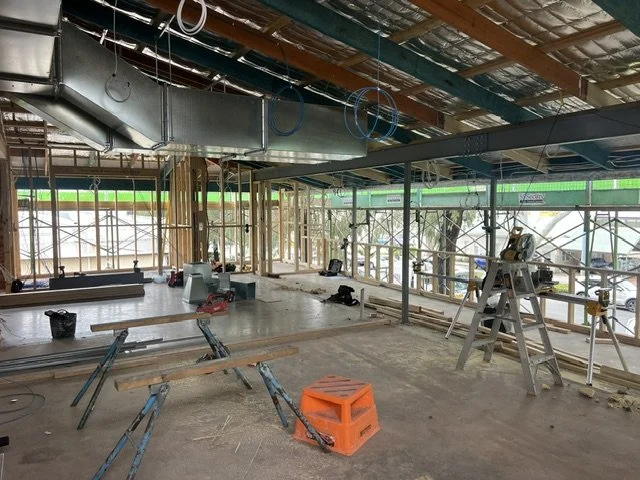

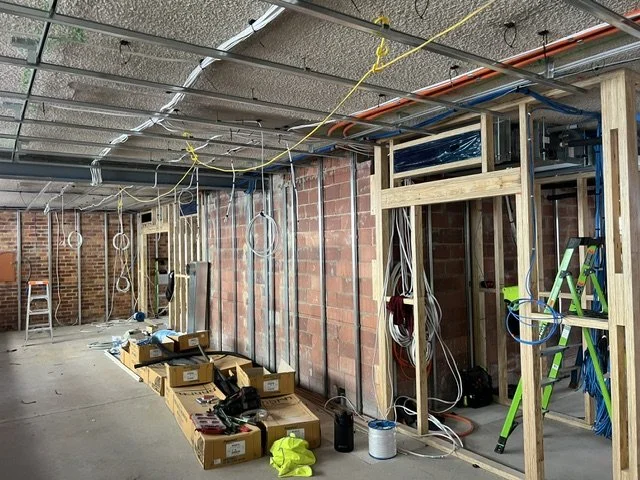

The gyprockers have commenced on site and are progressing with wall battening, framing set-out, and marking out for the ceiling works.
Scaffolding and external works

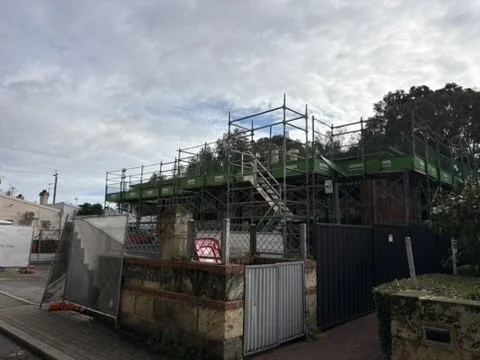

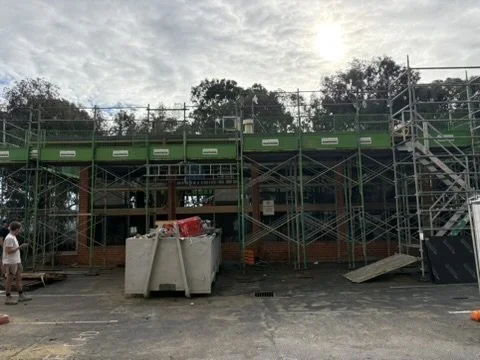

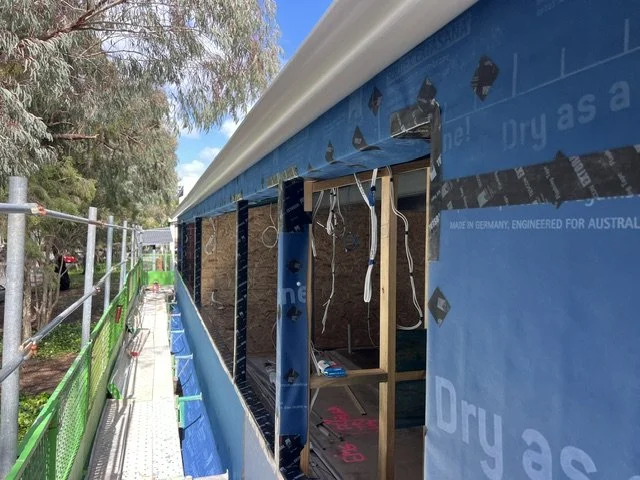

Scaffolding has now been fully erected, providing access to commence the replacement of the external timber beams along the northern and western elevations.
Subject to material availability, these works are scheduled to commence within the next week.
Programme and Trade Scheduling
Now that the further consultant and structural drawings have been received, we have been able to progress trade bookings and sequencing.
The construction programme and schedule are now close to being finalised, with the updated consultant information allowing us to lock in the next stages of work.
-
Provided by Site Supervisor Greg Dowse
Awaiting on final FFE levels, finishes, CEO bathroom details outstanding electrical details
Stage 1 and Stage 2 remain separate projects.
The architect has confirmed that the client has instructed that Stage 2 be progressed independently from Stage 1.
As a result, Stage 2 design documentation is still in the early stages, with the architect only recently submitting their fee proposal. Stage 2 drawings are therefore expected to be several months away from completion.
Waiting on drawings and information from
The solar consultants
Civil engineer regarding stormwater and associated civil works.
Project Budget Review
As the design and scope have evolved considerably since the project commenced, we have discussed with the team the need to undertake our own Quantity Surveyor (QS) review once a completed set of drawings has been received.
Until the design documentation is finalised and a QS review has been completed, we are unable to confirm whether the project will remain within the original budget.
Due to the above contributing factors, delays to the overall completion of the project are expected.
-
Provided by Site Supervisor Greg Dowse
All trades inducted; site protocols and emergency procedures communicated.
Structural steel has been installed on ground floor.
Structural grout between the steel beams and the suspended slab will start being applied next week.

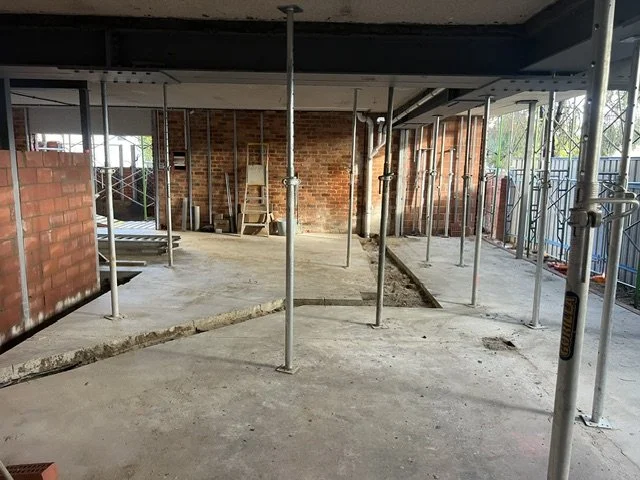

Bricklayers have commenced on site.
Bricklayer has completed the outer skin on the ground floor on both the Eastern and Western side

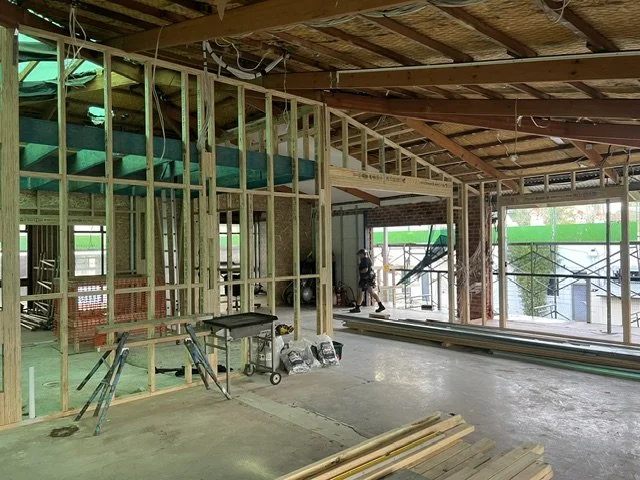

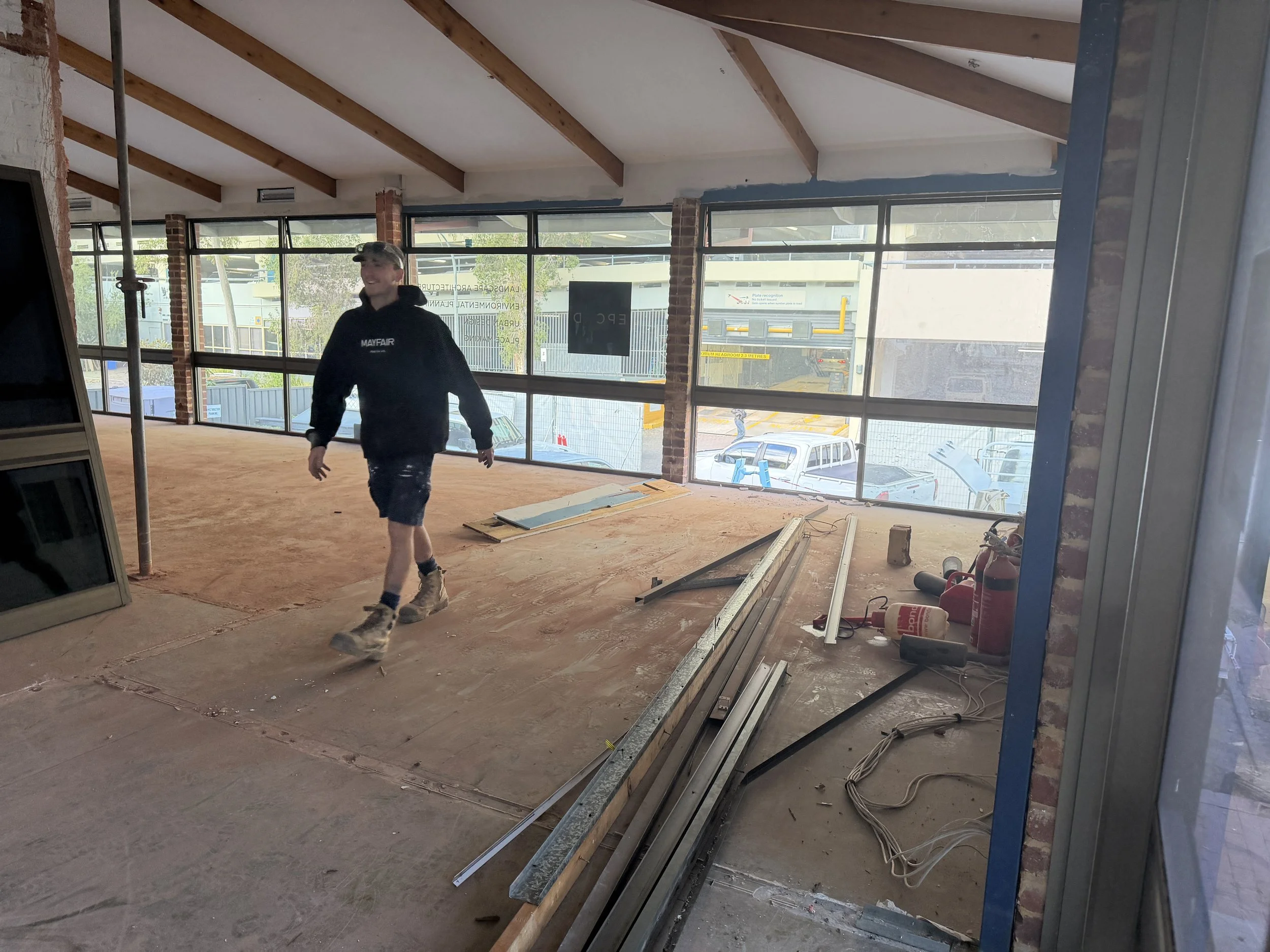

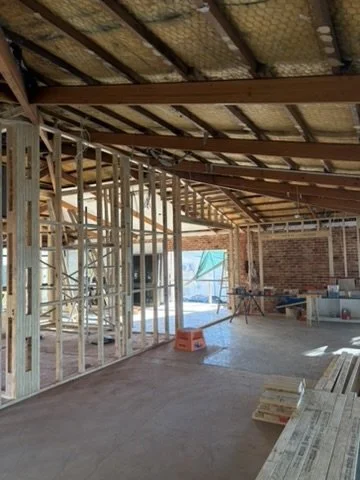

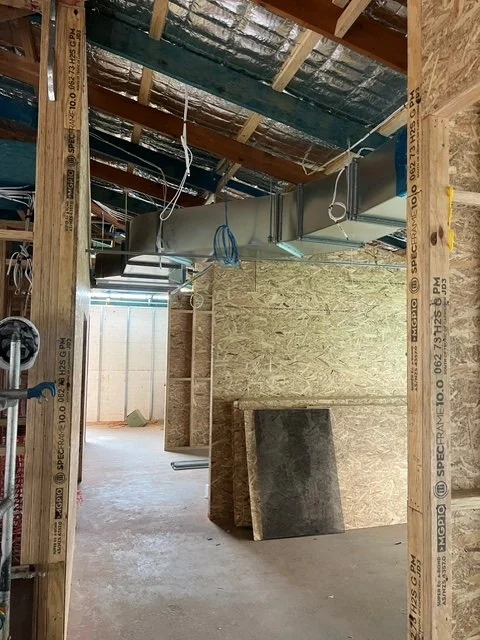

Framework is well underway on the top floor

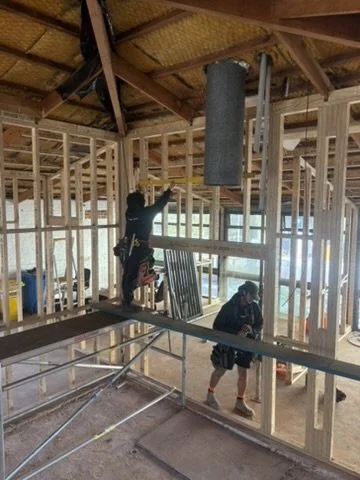

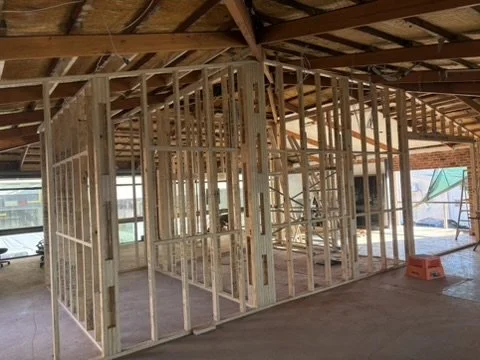

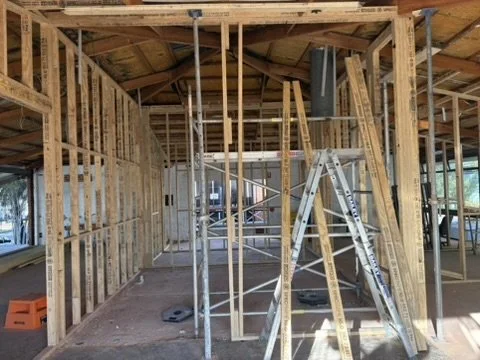

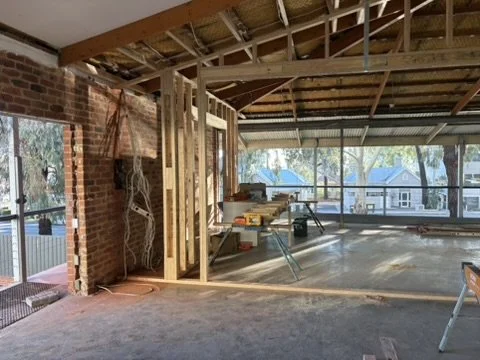

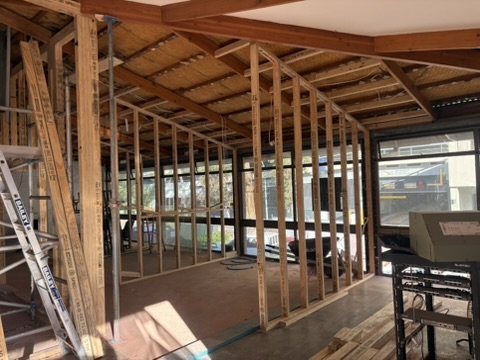

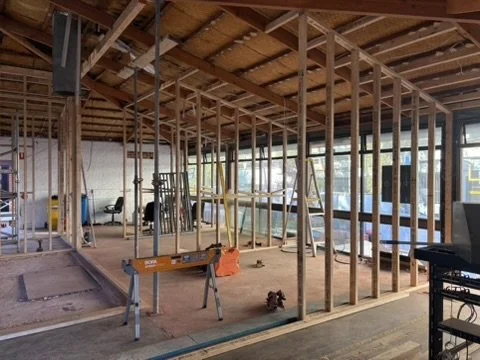

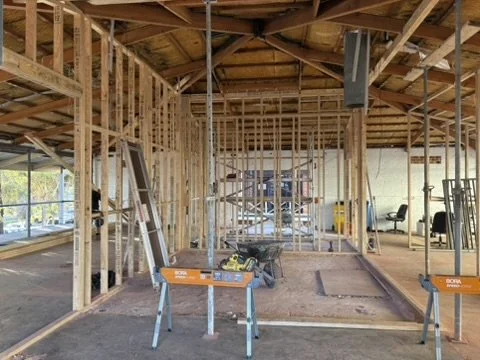

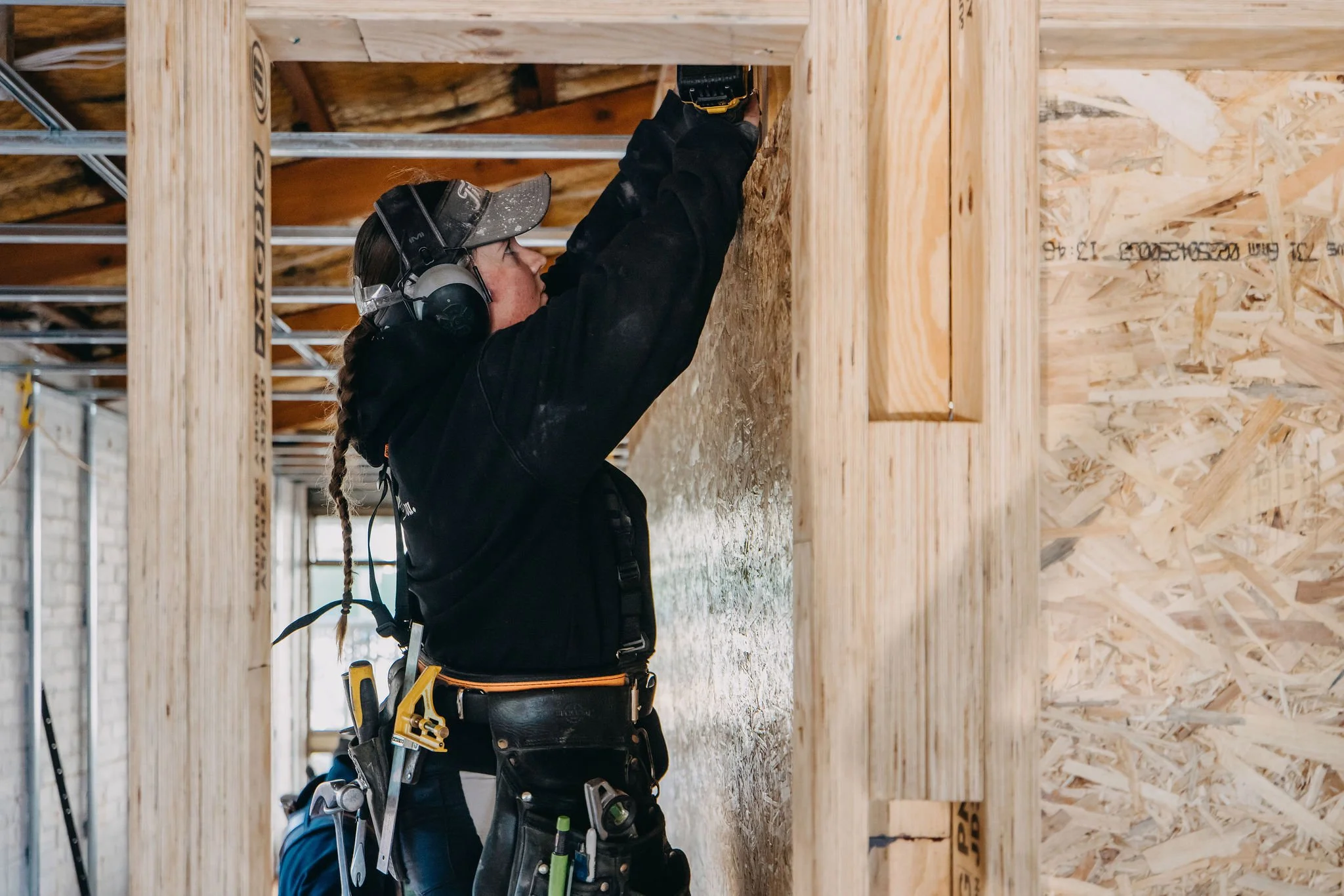

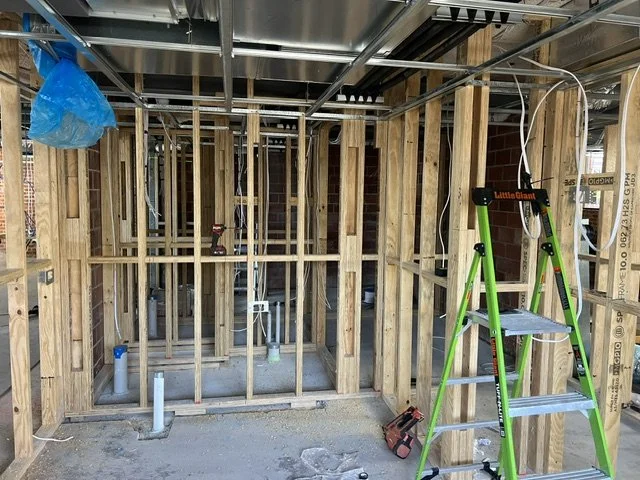

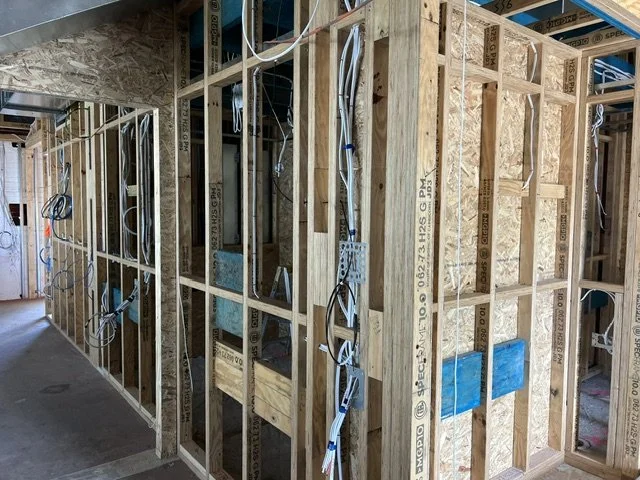

Mayfair team have been pushing hard to complete all internal framing on the top floor.
Following a review of the dimensions shown on the plans, it was determined that the remaining upstairs brickwork would need to be removed to maintain compliance within the bathroom and toilet areas.
Air conditioning contractor has sent though his revised drawings for Mata to work through.
Waiting on the completed structural drawings
Meeting with the Roofing contractor next week to discuss timeline and method of instillation
Scaffolding has been arranged for 1st week on July
Awaiting final completion and confirmation of electrical design, Hydraulic and Structural documentation..
-
Provided by Site Supervisor Greg Dowse
Awaiting on final FFE levels, finishes, CEO bathroom details outstanding electrical and Hydraulic requirements.
Stage 1 and Stage 2 remain separate projects.
The architect has confirmed that the client has instructed that Stage 2 be progressed independently from Stage 1.
As a result, Stage 2 design documentation is still in the early stages, with the architect only recently submitting their fee proposal. Stage 2 drawings are therefore expected to be several months away from completion.
Waiting on drawings and information from
The solar consultants
Civil engineer regarding storm water and associated civil works.
Awaiting updated structural drawings and details regarding the proposed roof structure modifications. Given these works are weather-sensitive and we are currently in the winter period, the timing and methodology are critical. Until this information is received and reviewed, we are unable to finalise the programme or provide a reliable construction timeline.
These unresolved items are preventing:
Finalisation of cost-to-complete
Development of a definitive construction programme
Project Budget Review
As the design and scope have evolved considerably since the project commenced, we have discussed with the team the need to undertake our own Quantity Surveyor (QS) review once a completed set of drawings has been received.
Until the design documentation is finalised and a QS review has been completed, we are unable to confirm whether the project will remain within the original budget.
Due to the above contributing factors, delays to the overall completion of the project are expected.
-
Provided by Site Supervisor Greg Dowse
Structural steel has been delivered and is on site
All required lifting equipment has now been delivered to site

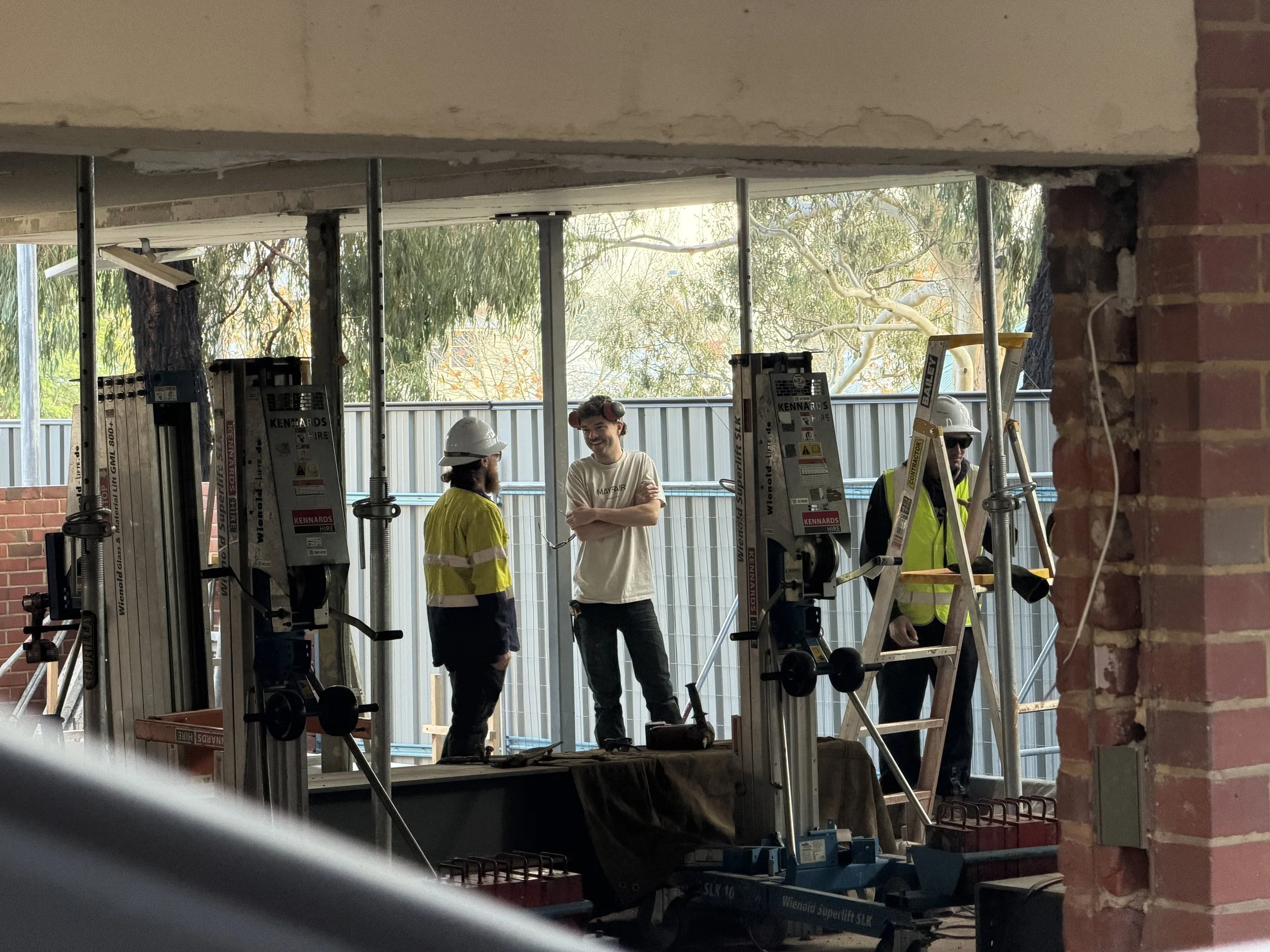

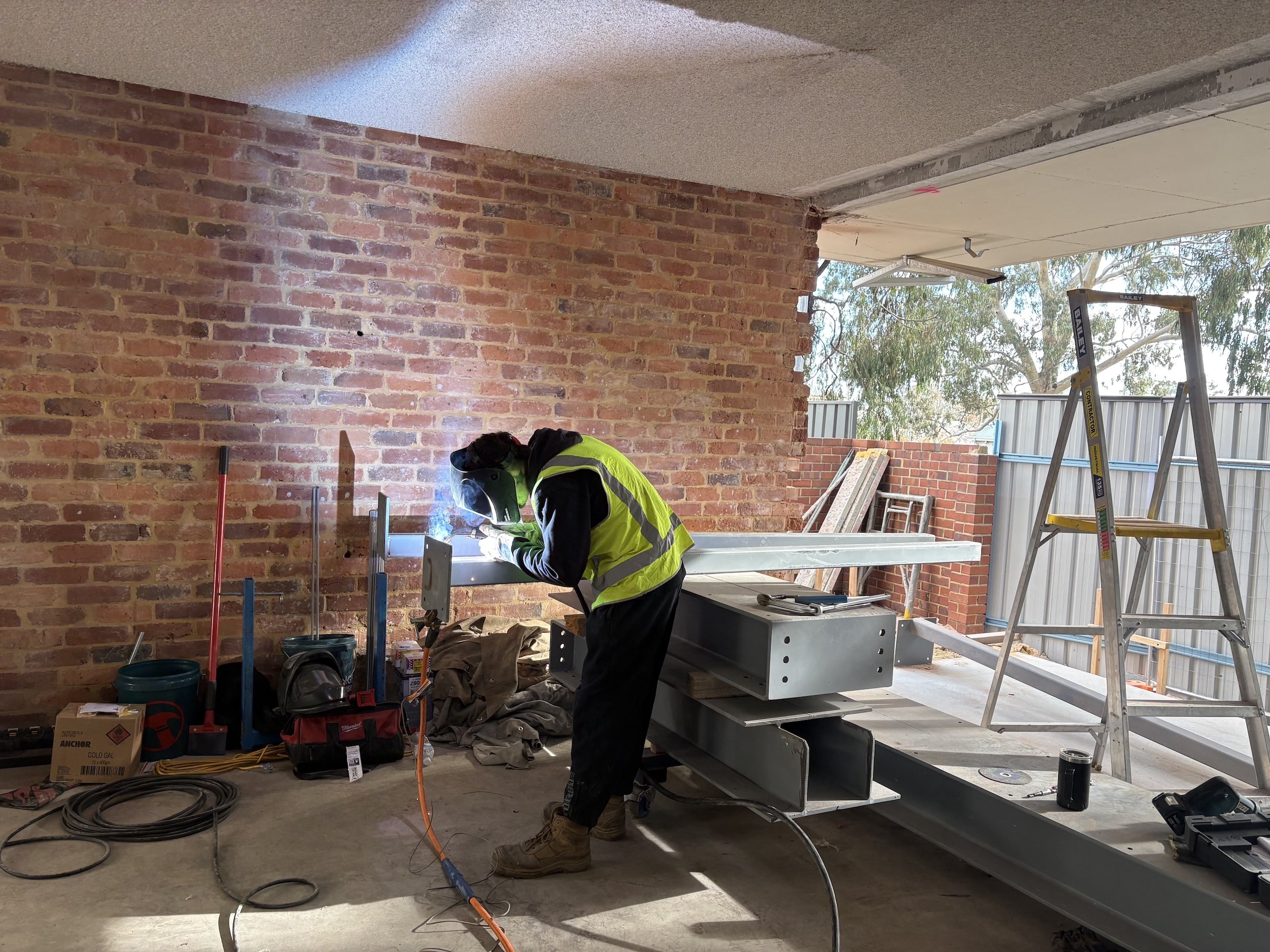

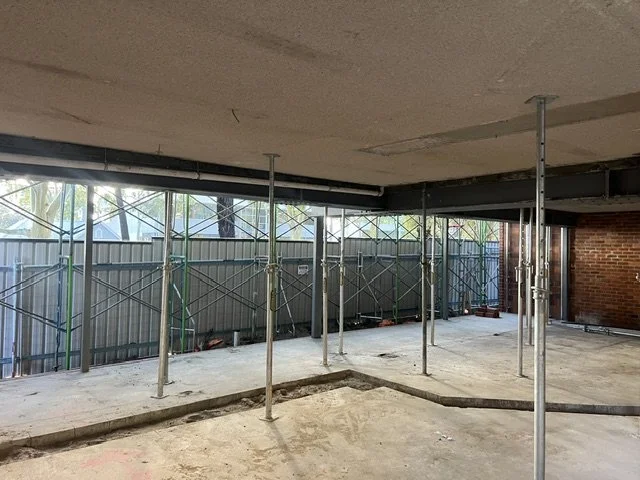

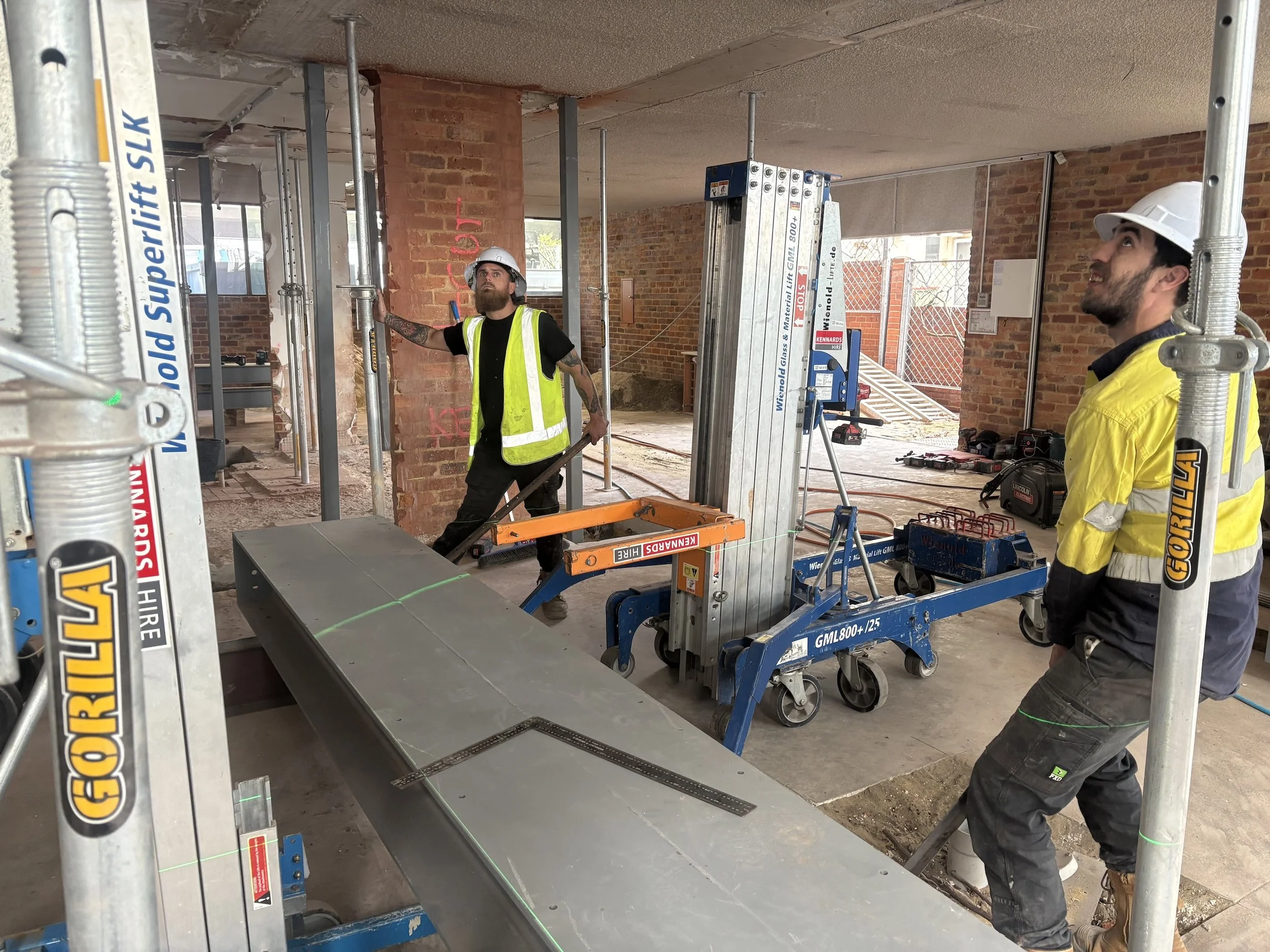

Installation of steel beams and posts has now commenced. These works are anticipated to take approximately two weeks.
Bricklayers have commenced on site.
There may be minor delays to some bricklaying works depending on the structural steel installation programme

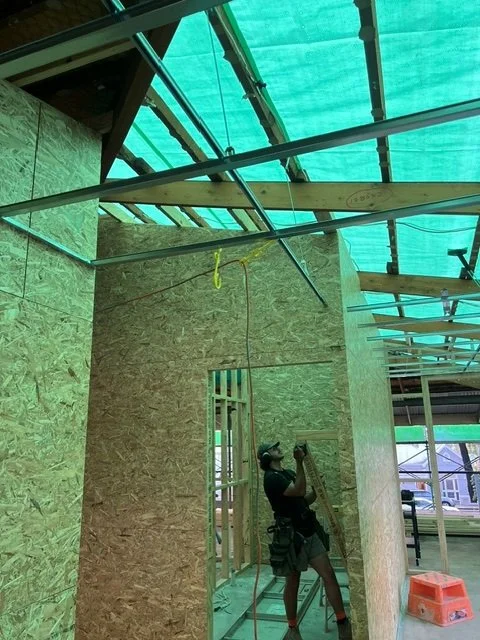

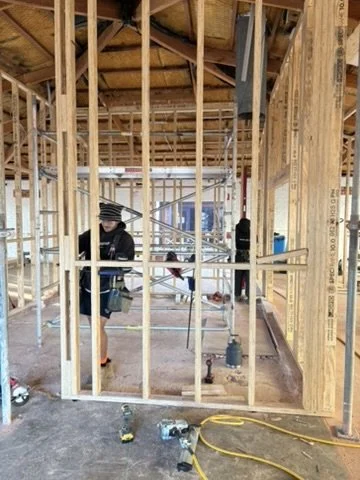

Framing works anticipate commencing next week.
All internal framing timber has been ordered and is scheduled to be delivered next week.

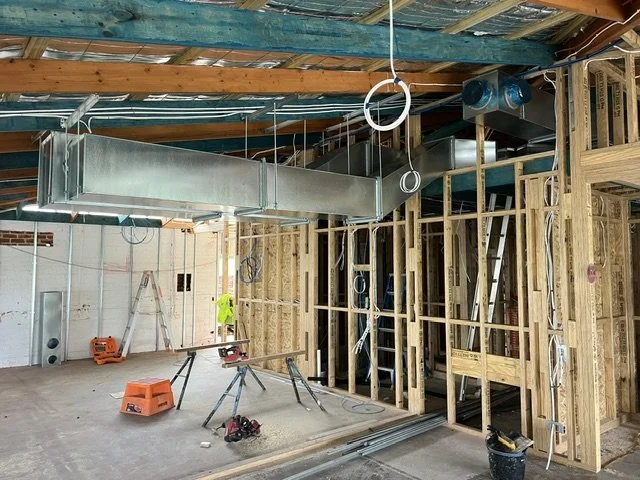

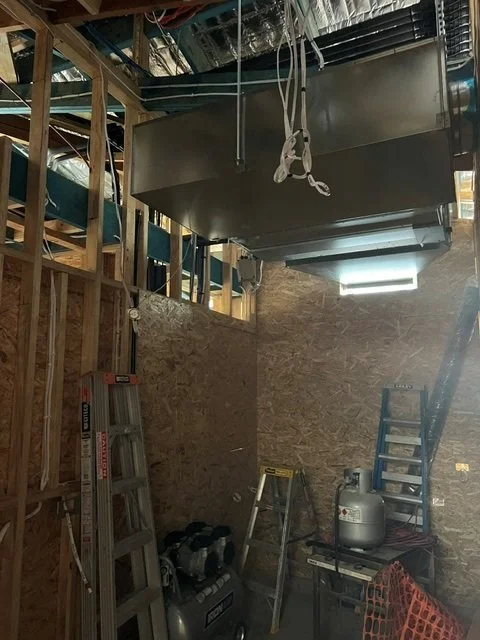

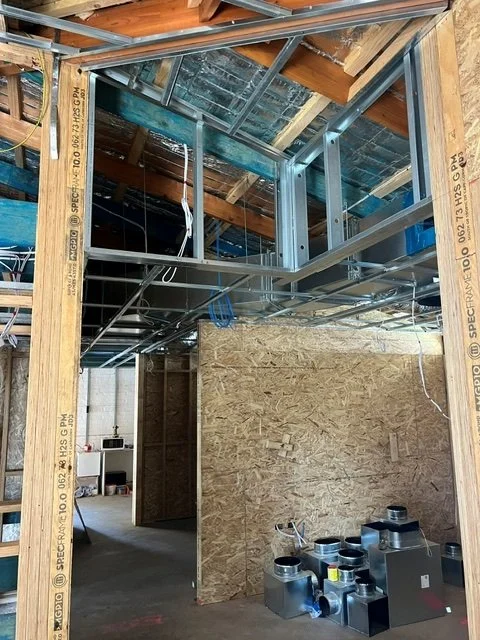

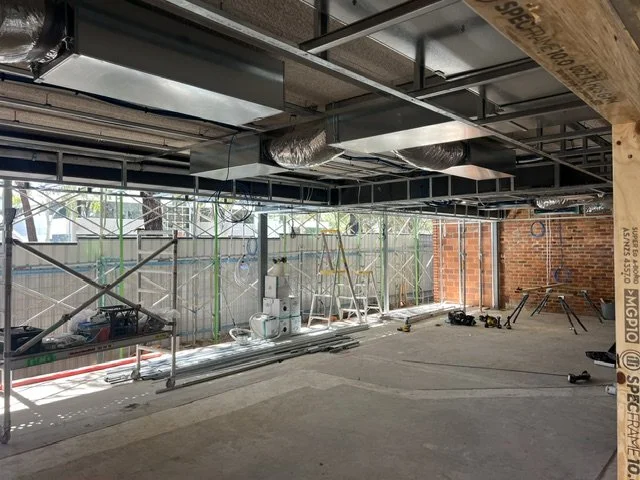

Continued coordination with air conditioning consultants regarding bulkhead ceiling heights, tolerances, and associated detailing.
A meeting has been held with MATA and the consultants, and a number of alternative solutions have been identified for the tolerance issues.
Air conditioning drawings have been completed, with outstanding queries currently being reviewed by the architect and project team.
Manufacturing of sheet metal components will commence once consultant queries are finalised.

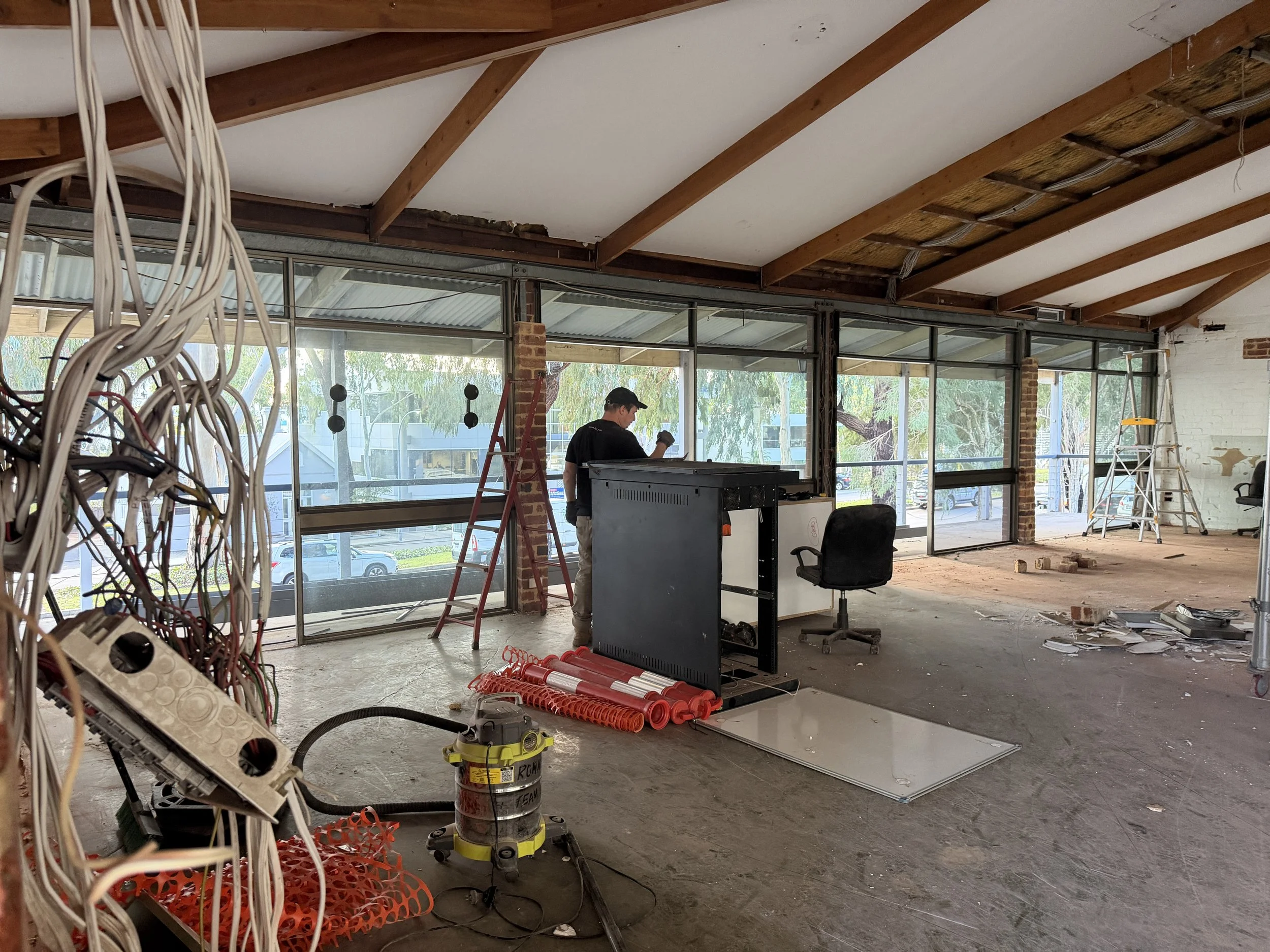

Awaiting final completion and confirmation of electrical design and Hydraulic documentation..
Waiting on final construction drawings to be issued.
The architect is currently awaiting confirmation from the client before these can be issued.
Consultant drawings relating to Graeme’s ensuite are still required prior to progressing the associated works.
-
Provided by Site Supervisor Greg Dowse
Awaiting final decisions on FFE levels, finishes, CEO bathroom details outstanding electrical and Hydraulic requirements.
Pending details relating to Stage 2.
I have spoken with MATA, who has confirmed that the client has directed them to keep Stage 2 separate from Stage 1.
MATA have only recently submitted their fee proposal for Stage 2.
As a result, Stage 2 drawings are expected to be several months away
As a solar consultant has only recently been engaged, the electrical design will need to be reviewed, redesigned, and reconfigured accordingly.
A civil engineer has only just been appointed, and there are currently no confirmed plans regarding stormwater and associated civil works.
There has been limited transparency from the client during the design stage, which has impacted our ability to clearly assess scope, budget, and programme requirements.
These unresolved items are preventing:
Finalisation of cost-to-complete
Development of a definitive construction programme
Confirmation of the overall project budget position.
Furthermore, as details and plans have changed significantly, it is recommended that we commission our own QS review
The original QS report has not been shared with us and would likely have been based on the CDC drawings, which are basic in nature.
As such, I cannot currently confirm that the project will remain within the original budget.
Due to the above contributing factors, delays to the overall completion of the project are expected.
-
Provided by Site Supervisor Greg Dowse
All footings and pylons have now been completed and concreted.
Formwork and reinforcement steelwork completed and certified by Jason.
Concrete slabs have been poured final major structural component of the pad.
Structural steel has been delivered and is on site
Structural steel installation to commence on Wednesday 3rd June.
Bricklayers currently scheduled to commence on 2nd of June, subject to progress of structural steel installation.
Potential minor delay to bricklaying works depending on steel installation programme.
Framing works anticipated to commence once structural steel and labour resources become available.
Continued coordination with air conditioning consultants regarding bulkhead ceiling heights, tolerances, and associated detailing.
Air conditioning drawings completed; outstanding queries currently being reviewed by the architect and project team.
Manufacturing of sheet metal componentry to commence once consultant queries are finalised.
Awaiting final completion and confirmation of electrical design documentation.
Updated architectural drawings received from Marta, including further detailing to Graeme’s ensuite.
Awaiting consultant drawings relating to Graeme’s ensuite prior to progressing associated works.
-
Provided by Site Supervisor Greg Dowse
Awaiting final decisions on FFE levels, finishes, CEO bathroom details outstanding electrical and Hydraulic requirements.
Pending details relating to stage 2
As a solar consultant has only recently been engaged, the electrical design will need to be reviewed, redesigned, and reconfigured accordingly.
A civil engineer has only just been appointed, and there are currently no confirmed plans regarding stormwater and associated civil works. These unresolved items are preventing:
Finalisation of cost-to-complete
Development of a definitive construction programme
Delayed finish
-
Provided by Site Supervisor Greg Dowse
All footings and pylons have now been completed and concreted. Formwork and reinforcement steelwork completed and certified by Jason. Concrete slabs pour scheduled/completed today, marking the final major structural component of the pad.
Structural steel has been measured and ordered, with delivery currently expected Wednesday, 13 May 2026. Structural steel installation to commence shortly after delivery.
Bricklayers scheduled to commence on 18th May 2026, subject to progress of structural steel installation. Potential minor delay to bricklaying works depending on steel delivery and installation programme.
Framing works anticipated to commence once structural steel and labour resources become available.
Continued coordination with air conditioning consultants regarding bulkhead ceiling heights, tolerances, and associated detailing. Air conditioning drawings completed; outstanding queries currently being reviewed by the architect and project team.
Manufacturing of sheet metal component to commence once consultant queries are finalised.
Awaiting final completion and confirmation of electrical design documentation.
Updated architectural drawings received from Mata, including further detailing to Graeme’s ensuite.
Awaiting consultant drawings relating to Graeme’s ensuite prior to progressing associated works.
-
Provided by Site Supervisor Greg Dowse
Awaiting final decisions on FFE levels, finishes, CEO bathroom details outstanding electrical and Hydraulic requirements.
Pending details relating to stage 2
As a solar consultant has only recently been engaged, the electrical design will need to be reviewed, redesigned, and reconfigured accordingly.
A civil engineer has only just been appointed, and there are currently no confirmed plans regarding stormwater and associated civil works. These unresolved items are preventing:
Finalisation of cost-to-complete
Development of a definitive construction programme
Delayed finish
-
Provided by Site Supervisor Greg Dowse
Earthworks have been completed. We removed 15 cubic metres of sand, brought in new fill sand, levelled the ground, and compacted the footing areas.
The concreters have commenced excavation of the footings and drilling of the pylons. Due to limited site access, progress has been slower than expected. We are aiming to complete this stage by Wednesday next week, at which point the concrete pylons and footings will be poured.
Additional sand will be brought in to achieve the required finished height, then compacted before the slab pad is poured. We are hopeful this will be completed by Friday next week.
We have begun site measurements for steel and other materials, with orders scheduled to be placed early next week.
Trees and stumps have been removed from site.
-
Provided by Site Supervisor Greg Dowse
Awaiting final decisions on FFE levels, finishes, CEO bathroom layout, outstanding design items, and electrical requirements.
Pending confirmation on whether Stage 2 will be incorporated into Stage 1.
As a solar consultant has only recently been engaged, the electrical design will need to be reviewed, redesigned, and reconfigured accordingly.
A civil engineer has not yet been appointed, and there are currently no confirmed plans regarding stormwater and associated civil works.These unresolved items are preventing:
Finalisation of cost-to-complete
Development of a definitive construction programme
Delayed finish
-
Provided by Site Supervisor Greg Dowse
Met with tree removal contractor; works scheduled for 9–10 April.
Commenced demolition of internal and external walls; 3x 10m³ of rubble removed to date.
Concrete has been engaged and confirmed for installation works commencing 13 April 2026.
Stage 2 (Hall & Prior building) meeting pod: bulkhead installed and partitioning completed.
-
Provided by Site Supervisor Greg Dowse
Awaiting final decisions on FFE levels, finishes, CEO bathroom layout, and outstanding design items.
Pending confirmation on whether Stage 2 will be incorporated into Stage 1.
These unresolved items are preventing:
Finalisation of cost-to-complete
Development of a definitive construction programme
-
Provided by Site Supervisor Greg Dowse
Met with the air-conditioning contractor to review the plans and liaised with the architect. Updated mechanical drawings have now been received.
Confirmed the scope for the internal and external doors. A quote has been received, contractor queries have been worked through, and the plans are being updated to reflect the revised door heights.
Met with the concrete contractor to review scope and programme timelines, and the final quote has now been received.
Liaised with the plumbers and arranged for decommissioning of reticulation, soak wells and associated services.
Measured up and prepared a drawing for the fencing contractor to enable quoting.
Arranged for the walls to be marked up for cutting works. Currently awaiting the demolition permit before proceeding.
-
Provided by Site Supervisor Greg Dowse
Awaiting decisions regarding FFE levels, finishes, the CEO’s bathroom and other outstanding design items.
Awaiting confirmation as to whether Stage 2 will be incorporated into Stage 1.
Incomplete documentation and delayed design decisions will inevitably impact both commencement and completion dates.
These outstanding items are also preventing finalisation of an accurate cost-to-complete and a definitive construction programme
CONTRACT SUMMARY
Updated 17 July 2026
SITE PHOTOS

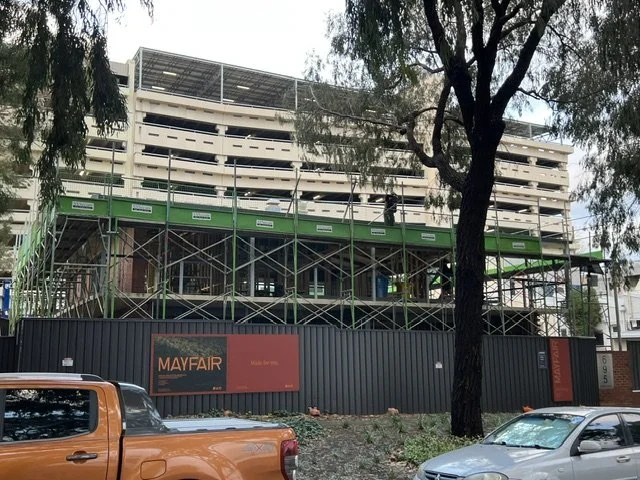

General Progress |17/07/2026
General Progress |03/07/2026

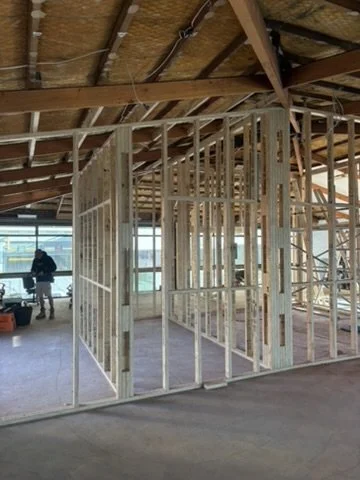

Internal Timber Framing | 19/06/2026
Internal Steelworks | 05/06/2026
Internal Demolition | 24/04/2026
Tree Removal | 09/04/2026

VARIATIONS & EXTENSIONS OF TIME
Updated 17 July 2026
HOLD POINT & EXPOSURE REGISTERS
Updated 17 July 2026
TEAM COMMUNICATION
Due to the project’s proximity to the Hall & Prior Head Office, regular stakeholder communications have been issued throughout the works to ensure Hall & Prior employees remain informed of upcoming site activities, particularly those involving noise, access impacts or potential disruption.
These communications have been coordinated by Lauren Gavriel, Project & Communications Manager, and circulated internally to assist with operational awareness and minimise disruption to surrounding staff and operations.
Below is a log of communications issued to date - click to read.
RENDERS, SELECTIONS & PROJECT DOCUMENTS
For an extensive overview of renders, selections and project documents please view here (link to a dropbox)
